Too Much, Too Little, Too Late - An Assembly Investigation of CONNECTIONS - New York's Statewide Child Welfare Computer System

Scott M. Stringer, Chairman
Oversight, Analysis and
Investigation Committee

NYS Seal

Roger L. Green, Chairman
Children and Families
Committee

March, 2001



ACKNOWLEDGMENTS

This investigation involved the input of many people. The Committee Chairs, William L. Parment and subsequently Scott M. Stringer, and Roger L. Green, provided guidance and direction to Committee staff throughout. Much of the research was conducted under the leadership of Assemblyman Parment, former Chair of the Committee on Oversight, Analysis and Investigation. In January 2001, Assemblyman Stringer took over as Committee Chair. Along with Children and Families Committee Chairman Green, Chairman Stringer has assumed the task of completing this report, implementing its recommendations, and helping to ensure ongoing legislative oversight of the CONNECTIONS project. Assemblywoman Susan John, former Chair of the Governmental Operations Committee, also offered critical insights during the Committees' public hearings.

The principal researcher and report drafter was Virginia Rosenbloom, Policy Analyst with the Oversight Committee. Her work included reviewing thousands of pages of procurement documents, analyzing financial information, and meeting with Administration personnel and other stakeholders.

Andrea Zaretzki, Executive Director of the Oversight Committee, provided vital insight, direction and editorial support, from the investigation's inception through report completion.

A number of Oversight Committee staff played key roles. Committee Counsel Tom Fox provided legal guidance, including assistance in developing the report's legislative recommendations. Policy Analyst Mark Hennessey conducted research and data analysis, and provided technical support. Michael Benjamin, Senior Legislative Associate, and Ralph Kulseng, former Committee Senior Policy Analyst, also helped out with research. All Committee staff played significant roles in preparing and presenting materials for the public hearings.

Other Assembly staff who contributed at various stages of the project included: Joanne Barker, Maria Torro, Mitzi Glenn, Sania Metzger, Eva Pierce, Beth Harbour, Linda Ashline, Julie Ruttan, Pat Fahy and Kris T. Reape. Additional input and guidance was provided by John Hudder, Janet Mannella, and Roman Hedges.

The Committees wish to acknowledge the cooperation and support received from the staff of the Governor's Office and the Office of Children and Family Services throughout this examination. The staff of the Office of State Comptroller also provided expertise and information critical in this effort.

Thanks to all.



TABLE OF CONTENTS


EXECUTIVE SUMMARY

  1. INTRODUCTION

    1. Background of Study

    2. History of CONNECTIONS

    3. New York's Child Welfare System

    4. Focus of Examination

    5. Overview of the Study

  2. PROBLEMS WITH THE CONNECTIONS SYSTEM
    AND THEIR IMPACTS ON CHILDREN AND FAMILIES

    1. Findings

    2. Recommendations

  3. PROCUREMENT ISSUES

    1. Introduction

      1. Background of New York's Technology
        Procurement Process

      2. The CONNECTIONS Procurement Process

    2. Findings

    3. Recommendations

  4. CONTRACT MANAGEMENT AND ADMINISTRATION

    1. Findings

    2. Recommendations

  5. FISCAL IMPACTS

    1. Findings

    2. Recommendations

APPENDIX
Abbreviations Used in this Report



EXECUTIVE SUMMARY


A.     PURPOSE OF THE INVESTIGATION

This report examines the procurement, development, and impact on children and families of the Office of Children and Family Services'1 CONNECTIONS computer system. This system was the State's answer to a 1993 federal law which encouraged states to create Statewide Automated Child Welfare Information Systems (SACWIS). It was intended to track the tens of thousands of children receiving various child welfare services across New York State. CONNECTIONS was also designed to connect the State agency with the counties and not-for-profit agencies that provide these services.

The Committees' interest in CONNECTIONS is two-fold. First, the Assembly Committees on Oversight, Analysis and Investigation and on Children and Families had previously identified problems with the CONNECTIONS system as a result of their earlier examination of the State's foster care system. Some of these problems were documented in the Committees' May 1999 report LOSING OUR CHILDREN: An Examination of New York's Foster Care System. The current investigation was intended to follow up on issues raised about CONNECTIONS during that earlier study.

In addition, the Committee on Oversight, Analysis and Investigation focused on the CONNECTIONS procurement as part of its broader examination of New York's computer technology procurement practices. CONNECTIONS is one of the largest information technology projects undertaken by the State (the cost of the project overall has grown to over $362 million). Together, the two main contracts the State entered into to build the system place CONNECTIONS in the top ten most expensive procurements covered by the Procurement Stewardship Act.2

This report presents the Committees' findings, including quotes from system users and relevant documents. It also makes recommendations applicable to CONNECTIONS specifically, as well as for improving the State's information technology procurement process generally. It is the Committees' hope that similar problems will be avoided in other large current and future computer system projects.

B.     BACKGROUND ON CONNECTIONS

When the original contracts for the system were announced in 1996, Governor Pataki expressed high hopes for it:

"Our new system will allow child welfare caseworkers to spend less time shuffling paper and more time directly helping thousands of children in New York State who are vulnerable to abuse, neglect and abandonment."3

Yet five years later, the two main contracts have grown from $113.6 million to $216 million, only three out of five major components of the system are operational, and users complain that these parts do not work as intended and are unreliable. The case management portions of the system -- designed to keep track of children receiving services -- is not in place, and a system to enable local reporting is not expected to be available statewide until the end of 2001 at the earliest. Caseworkers on the front lines report that the system actually increases their administrative time rather than decreases it. They fear that children may continue to be at risk of abuse and neglect because of the inadequacies of CONNECTIONS.

In the words of Maximus, the contractor recently hired by the State to recommend how to fix CONNECTIONS' problems:

"…[L]ess than half of the system's capabilities has been implemented. Functionally, the software supports only the initial acceptance and investigation of allegations of reports of child abuse and neglect…while foster care, adoption, and preventive services programs are supported by the non-SACWIS Child Care Review Service (CCRS). This creates a dual working environment, additional costs, and end-user dissatisfaction."4

Maximus is conducting an entire re-assessment of CONNECTIONS' hardware and software. It is expected to recommend either fixing the components that have not been rolled out because they do not meet users' needs, or scrapping them and starting from scratch.

At an Assembly hearing in May 2000, Marjorie McLoughlin, Executive Director of Cardinal McCloskey Services -- a not-for-profit child welfare agency under contract with New York City -- told the Committees that her agency has been less able to serve the client population as a result of CONNECTIONS. She summed up her complaints with the system:

"What we have now is a poorly functioning system for some people, at great expense to all people, with aging equipment and with no demonstrable help to even a single caseworker, in the Voluntary Sector, much less to any child or family that we serve."5

Nicholas Scoppetta, Commissioner of New York City's Administration for Children's Services (ACS), also expressed dissatisfaction with the system's ability to meet expectations:

"We're enormously frustrated, so frustrated that we are spending millions of dollars for work-arounds because CONNECTIONS didn't work."6

Chautauqua County Social Services Commissioner Edwin Miner tied CONNECTIONS' inadequacies to a lack of proper vision and project planning:

"It was not designed with a vision for its interface with human beings. It is neither intuitive nor logical. Finally, it is slow, tedious and potentially fatally inaccurate."7

As recently as January 2001, the successful plaintiffs in an action brought against New York City and New York State argued that CONNECTIONS' failings hurt children and taxpayers, and that continued court intervention was needed:

"Every step of the way, this critically important accountability device has been delayed, mishandled, and mismanaged. Other than the hundreds of millions of taxpayer dollars that have been poured into a non-functional computer information system, the children of New York and the plaintiffs on whose behalf this settlement was negotiated are still without the protections of an adequate computerized state-wide information system."8

C.     OVERVIEW OF THE STUDY

Much of the research involved in this investigation was conducted in 1999 and 2000 under the leadership of William L. Parment, then-Chairman of the Oversight, Analysis and Investigation Committee. In January 2001, Assemblyman Scott M. Stringer took over as Chairman of the Committee. He has joined Assemblyman Roger L. Green, Chairman of the Committee on Children and Families in completing the report, implementing its recommendations, and helping to ensure ongoing Legislative oversight of the CONNECTIONS project.

Between the fall of 1999 and the spring of 2000, Oversight Committee staff examined the procurement record and related documents, spoke to State Comptroller and agency personnel, and reviewed various outside reports that cite CONNECTIONS. Joint public hearings were held by the Assembly Committees on Oversight, Analysis and Investigation, on Children and Families, and on Governmental Operations in May 2000. Testimony was received from various users of the system, including not-for-profit child welfare agencies, county social services commissioners, and unions representing State and county workers who use the system, as well as the State Comptroller, the contractors, and representatives from the Administration.

The investigation focused on the following issues:

  • To understand what the problems are with CONNECTIONS, the impacts of these problems on children and families, why the system is not working as intended, how the Administration plans to fix the system, and anticipated costs.

  • To learn from the procurement, design and implementation of CONNECTIONS, and to make recommendations that are both specific to CONNECTIONS and also can be applied systemically, with the hope of avoiding similar situations in the future.

This report brings together key issues and findings identified during the Committees' investigation. Summarized below are the key findings raised in the report, as well as administrative and legislative recommendations.

It is important that the Administration act quickly to complete the implementation of a properly functioning statewide child welfare information system. Until then, children may continue to be at an increased risk of abuse or neglect, costs will continue to rise, services will suffer, and the implementation of major child welfare programs will be hampered. Such programs include the federal Adoption and Safe Families Act of 1997 (ASFA) and New York City's Neighborhood-Based Child Welfare Services initiative. While the Administration has made recent efforts to solicit the needs of system users and to reassess the system as a whole, more needs to be done, and quickly.

D.     FINDINGS AND RECOMMENDATIONS

PROBLEMS WITH THE CONNECTIONS SYSTEM AND THEIR IMPACTS ON CHILDREN AND FAMILIES

Findings

  • Despite the Office's and the contractors' public claims, when pressed, the Administration admits the system is incomplete and doesn't work as intended. Major portions of the system have not been implemented, and those that have require fixes and modifications.

  • The problems created by CONNECTIONS have had a negative impact on children and families and service delivery. Examples include:

    • Inaccurate searches in the system for known child abusers may come up with nothing. As a result, investigations may be closed, leaving children in dangerous situations. Child Abuse Registry workers fear that there have been problems with 40% of the searches since July 1996.
    • Backlogs of clearances against the Child Abuse Registry cost some prospective workers their jobs.
    • Because of the cumbersome nature of CONNECTIONS, and the increased administrative burden and duplicate data entry it has caused, caseworkers have less time to spend directly helping children and families.
    • Providers in New York City have been unable to meet requirements to place children in their own communities because of delays in receiving CONNECTIONS hardware and software.
    • Providers have to rely on the State's old systems, and develop their own alternative systems -- at their own cost -- to track information CONNECTIONS was supposed to track. This is particularly true for case management and ASFA requirements.
    • Inadequate management reports hinder supervision of casework and decision-making, potentially affecting service delivery.

  • Until CONNECTIONS is fixed and fully implemented, problems identified in State Comptroller audits -- which CONNECTIONS was intended to remedy -- remain. Two recent court settlements also require implementing a functioning CONNECTIONS system to ensure that services are being delivered.

Recommendations

Administrative

  • Many of these problems resulted from a lack of user input during system design and implementation. The Office should continue to work closely with the CONNECTIONS user community -- including local districts, contract agencies, and State workers -- to identify system modifications that will address their needs and help them to achieve their mission. The completed system, which originally promised to save caseworkers time, should at least be time-demand neutral.

  • The Committees reiterate their recommendation from their earlier report, LOSING OUR CHILDREN, that the Office should significantly increase its supervision of the local districts to ensure that State programs are being implemented as intended and that children and families are being served. This is especially important in light of the Comptroller's findings that CONNECTIONS has failed to fulfill its role as a tool to aid in State agency oversight.

  • The Committees also recommend that the State Comptroller continue to monitor the Office's efforts to supervise local district operations.

Legislative

  • Until CONNECTIONS is operational, the Office should take interim steps to address Comptroller audit recommendations, and should keep the Governor, Comptroller, and Legislature apprised of these steps. Currently, agencies are only required to file with these entities one report -- due 90 days after an audit is issued -- that shows their efforts to implement audit recommendations. One report often does not present a full picture of an agency's compliance activities.

    Legislation has been introduced (A.5626) to address the need for continued monitoring of agency actions in response to audit recommendations -- not just in the CONNECTIONS case. This bill would require that all audited agencies continue providing 90 day updates to the Governor, Comptroller, and Legislature until all agreed upon recommendations are implemented. It also provides that the Comptroller may do follow-up audits to determine the extent to which recommendations have been implemented.

PROCUREMENT ISSUES

Findings

  • The evidence indicates that the CONNECTIONS procurement in some instances violated the principles of the State's procurement law. In other instances, deficiencies in the law allowed for irregularities in the procurement process. The following actions by the Administration raise questions about the fairness of the procurement, and whether or not the State made a best value award as defined in the statute:

    • awarding contracts to two vendors instead of one, as outlined in the original Request for Proposals, without conducting a new procurement,
    • changing the criteria against which vendor proposals were judged, after seeing the initial offers,
    • at the last minute, calling the procurement an emergency,
    • overriding recommendations of technical and financial committees which evaluated the proposals,
    • authorizing work to begin before obtaining Comptroller approval,
    • maintaining an incomplete procurement record; therefore key decisions and who made them cannot be discerned,
    • ignoring requirements of Executive Order No. 189 to appoint a Procurement Integrity Officer, which was designed to detect and prevent improper contacts and lobbying by firms with proposals before the agency.

  • Ultimately, the record is unclear as to who was responsible, and accountable, for many major decisions in the CONNECTIONS project. What is clear is that the Governor's office played a critical role in key decisions -- both during the contracting process and during early implementation -- that led to problems that exist today.

Recommendations

Administrative

  • Potential vendors should be afforded the opportunity, up front, to know how their proposals will be evaluated. Making vendors aware of what is expected of them and what the agency deems important can help better ensure a truly competitive procurement, and can hopefully avoid misunderstandings between the vendor and the State after contract award. A recent statutory change requiring that agencies not change evaluation criteria after the receipt of initial offers hopefully clarifies the issue first brought up in the Transactive case.9 Agencies should also disclose in the Request for Proposals (RFP), to the maximum extent possible, the detailed evaluation criteria that will be used to select the successful vendor.

  • Executive Order No. 189 -- which requires each agency head to designate a Procurement Integrity Officer to receive reports of contacts between agency personnel and vendors -- should be followed and enforced by the Executive. This Executive Order was intended to preserve the integrity of the procurement process by preventing improper lobbying influences.

  • Documentation of contacts that are required to be reported to the Procurement Integrity Officer should be made part of the relevant procurement record.

Legislative

  • A formal mechanism should be established in statute so bidders have a right to challenge what they think is an unfair procurement. The statute should set forth the broad outline of the bid protest process, and require the Comptroller to implement the statute.

  • State statute should require that, except in extraordinary circumstances, agencies must disclose in the RFP the detailed evaluation criteria that will be used to select the successful vendor.

  • Executive Order No. 189 should be codified in statute.

  • The Emergency provision of the law should be strengthened. This may be done in several ways, which are not mutually exclusive:

    • As previously recommended by the Assembly, codifying the language of the Procurement Council Guidelines that stated that an agency's failure to properly plan in advance does not constitute an emergency.
    • Requiring that an Emergency procurement be declared by the Governor, rather than a management-level designee in an agency.
    • Adopting language from Chapter 116, Laws of 2000, amending section 3-0301 (2) of the Environmental Conservation Law relating to construction emergencies, to, among other things, clearly express the limited nature of such procurements.

  • Legislation is needed to address the problem of State agencies proceeding with implementing contracts that have not yet been approved by the Comptroller. One approach is to establish some mechanism to ensure that an agency does not preempt Comptroller review by accepting delivery of goods or services before a contract receives the required approval.

CONTRACT MANAGEMENT AND ADMINISTRATION

Findings

  • The State agency failed to adequately manage work required under the contracts and subsequent change orders, and project implementation.

  • The contract and amendments negotiated with Andersen Consulting 10 to develop the software contributed to current problems with the system.

    • The procurement was originally supposed to result in a specified product for a fixed price, but the contract and amendments changed this to a time and materials basis;
    • The State and Andersen severely underestimated the amount of work needed to customize the software for New York; the effort grew from 5,500 days to over 28,000 days in the first year, and continues to grow. Even with this large increase, it has failed to meet 60% of users' needs;
    • The contract language left the State in a poor position to enforce the contract; the liability provisions clearly favored Andersen.

  • The contract and change orders negotiated with ISSC (a subsidiary of IBM)11 may not have provided the best value to the State. From the beginning to the most recent change orders, IBM prices for CONNECTIONS equipment have exceeded market prices.

  • The large number and dollar amount of change orders involved with this project runs contrary to the best value principle in State law. Since their inception in 1996, the Andersen and IBM contracts have increased by 167% and 53% respectively, together representing an overall increase of 90% for the project.

  • The federal Administration for Children and Families (ACF) steered the Office to do what it should have done on its own as part of overall contract management. This included enforcing the original contracts with Andersen, and requiring new hardware and software be competitively bid. However, Andersen's unique programming language, not known or used by other vendors, may result in other vendors being unable to bid.

Recommendations

Administrative

  • The Administration must improve its ability to negotiate, enforce, and manage large computer technology contracts. Greater training and support for agency management involved in this function is needed. Statewide standards for technology contracts, including enforcement mechanisms, should be established. Recent efforts by the State Office for Technology (OFT) to help negotiate complex technology procurements, train project managers, and establish standard statewide technology contract provisions are promising. However, because OFT cannot be involved in every technology procurement and implementation, training should be available and required for agency personnel involved in contract negotiations, enforcement and management.

  • The State Comptroller should continue to monitor the Office's compliance with its audit recommendations to improve agency controls over change orders. In October 1998, in response to a Comptroller's audit, Commissioner Johnson had promised to take action in this regard.

FISCAL IMPACTS

Findings

  • It is hard to pin down the total cost of the system so far, and the Administration cannot tell us how much more it will cost.

    • The Committees estimate the cost to date to be around $362 million, not including the cost of fixing or replacing the case management and fiscal management components that were never implemented. This cost will not be known until Maximus and the State complete their re-assessment efforts, and a new procurement is done.

  • Even if we know the total cost, the State versus federal share remains unclear.

    • State appropriations so far total $115.5 million, with another $35.6 million proposed for 2001-02.
    • Due to delayed approval by the federal agency of certain CONNECTIONS costs, and ongoing audits of CONNECTIONS claims, the State faces the loss of federal reimbursement for the system. OCFS Commissioner Johnson has estimated that $40 million could be at risk. This does not include other penalties, such as those pending for not meeting federal AFCARS reporting requirements.

  • Local districts and contract providers are also experiencing added costs due to CONNECTIONS, including developing alternate computer and manual systems, additional time spent on recordkeeping in CONNECTIONS and other systems, overtime needed to complete fieldwork, and training workers on the system.

Recommendations

Administrative

  • The Governor's proposed 2001-02 budget includes $60.6 million in State and federal funding for CONNECTIONS. According to budget officials, this figure does not include any of the costs to deal with fixing or replacing "Release 4". In 2000, the Executive requested and the Legislature approved funding for a project integrator (Maximus), whose chief responsibility was to recommend how to proceed with the system's development. The Maximus report is now four months late. At the Legislative budget hearing on February 6, 2001, Commissioner Johnson indicated that Maximus had completed its report, and it was under review by OCFS.

    However, when this report went to print, the Legislature still had no indication from OCFS what any additional costs for completing the project would be. The Legislature must be provided as soon as possible with both the Maximus report and with the Executive's recommendations on how it plans to proceed. Only then is it reasonable to expect the Legislature to act on the Governor's proposed 2001-02 budget as it relates to CONNECTIONS.

Legislative

  • The Office must continue to keep the Legislature apprised of the status of CONNECTIONS implementation and costs. Pursuant to Legislative additions, the 2000-2001 budget required an expenditure plan be submitted to the Governor and the Legislative fiscal committees. It also required quarterly updates to this plan, including expenditures to date, anticipated future expenditures, and updates of project progress. The Governor's proposed 2001-02 budget does not continue this reporting requirement. Such reports should continue to be provided until the project's completion. Additional information should include anticipated and actual federal approvals and reimbursements, and contract amounts and expenditures to date.

    The proposed 2001-02 budget also does not continue the Legislature's earlier requirement that new work on CONNECTIONS be competitively bid. This should be a continued requirement.

  • In addition, the Office should provide the Legislature with a detailed accounting of all costs to date, and projected costs to complete this project, including developmental, operational and maintenance costs. Such a report should also show the State and federal share.

  1. Throughout this report, "the Office" is used to refer to the Office of Children and Family Services (OCFS) and its predecessor, the Department of Social Services (DSS), unless specifically noted otherwise.
  2. The Procurement Stewardship Act (Article 11, State Finance Law) was originally enacted in 1995. It was subsequently amended in 2000 and extended until June 30, 2005, and governs State purchases of information technology, as well as other goods and services.
  3. "Governor Pataki Announces High Tech Plan to Fight Child Abuse", (Press Release), February 29, 1996.
  4. Maximus proposal in response to OCFS' Project Integrator RFP, July 23, 1999, p.III-1.
  5. Written testimony of Marjorie McLoughlin, Executive Director, Cardinal McCloskey Services, May 12, 2000 public hearing.
  6. "Poor Equipment, Software Woes Plague Network", The Daily News, September 5, 2000, p.2.
  7. Written testimony of Edwin Miner, Commissioner, Chautauqua County Department of Social Services, p. 1.
  8. Memorandum in Support of Plaintiffs' Motion for an Order Directing Compliance with Certain Provisions of the Marisol State Settlement Agreement, submitted to the US District Court, Southern District of New York, January 2, 2001.
  9. Transactive Corp. v. Dept. Of Social Services, 236 A.D.2d 48 (3rd Dept. 1997).
  10. Andersen Consulting is now known as Accenture.
  11. ISSC is now known as IBM Global Services.



I.     INTRODUCTION


This report examines the procurement, development, and impact on children and families of the Office of Children and Family Services' CONNECTIONS computer system. This system was intended to track children receiving various child welfare services across New York State. CONNECTIONS was also designed to connect the State agency with the counties and not-for-profit agencies that provide these services. Data from the Office of Children and Family Services show that in 1999, 138,000 reports of child abuse or neglect were received by the State Central Registry of Child Abuse and Maltreatment; 42,000 children received preventive services; 47,700 children were in foster care at year end; and 3,400 were legally freed for adoption.12 So far, CONNECTIONS tracks information only on the children included in the child protective reports received by the Registry. Until CONNECTIONS is fully implemented, children receiving the other child welfare services are tracked in the State's old systems or in manual systems.

The report identifies numerous problems with the procurement, development and implementation of the CONNECTIONS system. It makes recommendations that are both specific to CONNECTIONS and also can be applied systemically, with the hope of avoiding similar situations in the future.

A.     BACKGROUND OF THE STUDY

The Committees' interest in CONNECTIONS is twofold. First, the Assembly Committees on Oversight, Analysis and Investigation and on Children and Families had previously identified problems with CONNECTIONS as a result of their earlier examination of the State's foster care system. Some of these problems were documented in the Committees' May 1999 report LOSING OUR CHILDREN: An Examination of New York's Foster Care System. Since then, other sources have pointed to continuing problems with the system, including State Comptroller audits, the federal Health and Human Services Inspector General, and numerous newspaper accounts in which local governments and not-for-profit agencies voiced complaints. The Committees' current investigation was intended to follow up on the issues raised about CONNECTIONS.

In addition, in the spring of 1999, the Assembly Standing Committee on Oversight, Analysis and Investigation initiated a broader examination of New York's computer technology procurement practices, to determine whether they are fair, effective and cost-efficient. At the time, the purchase of computers and information technology, as well as other goods and services purchased by State agencies, was governed by the State Procurement Stewardship Act of 1995 (the Act), which was due to sunset June 30, 2000. The Act has since been modified and extended until June 30, 2005. Certain provisions relating to information technology have changed, and will be discussed in this report.

The Committee focused on information technology contracts because of the large number and cost of computer projects undertaken by State agencies in recent years. Since 1995, the cost of information technology contracts as a percent of all contracts covered by the Act has more than doubled from 7% to 17%. At the end of State fiscal year 1995-1996, the State had entered into information technology contracts worth $1.3 billion. By the end of State fiscal year 1999-2000, this investment had more than tripled to $4.6 billion.13

As part of its broader examination, the Committee examined several key information technology contracts entered into pursuant to the Act. Of particular interest were those which have had bid protests lodged against them by unsuccessful bidders, which might indicate problems with the procurement process. Among these projects was CONNECTIONS.

CONNECTIONS is one of the largest information technology projects undertaken by the State (the cost of the project overall has grown to over $362 million). Together, the two main contracts with outside vendors that the State entered into to build the system place CONNECTIONS in the top ten most expensive procurements covered by the Act. These contracts now total $216 million of the$362 million total cost of the project to date.

When the original contracts to build CONNECTIONS were announced in 1996, Governor Pataki expressed high hopes for it:

"Our new system will allow child welfare caseworkers to spend less time shuffling paper and more time directly helping thousands of children in New York State who are vulnerable to abuse, neglect and abandonment."14

Then-Acting Commissioner Brian Wing of the Department of Social Services, the agency responsible for the project at the time, predicted:

"Connections will be a vital new tool in our work to improve the quality of child welfare services in New York. The true beneficiaries of the program will be the thousands of children and families served by the system."15

Yet five years later the system does not work as intended and contract costs have escalated from $113.6 million to $216 million. Caseworkers on the front lines report that the system actually increases their administrative time spent rather than decreases it. They fear that children may continue to be at risk of abuse and neglect because of the inadequacies of CONNECTIONS.

B.     HISTORY OF CONNECTIONS

CONNECTIONS is New York State's response to a 1993 federal law16 which encouraged states to create Statewide Automated Child Welfare Information Systems (SACWIS) to provide for effective management, tracking, and reporting of children in the child welfare system. Enhanced federal reimbursement of 75% was originally available through September 1996 for the planning, design, development and installation of the system. Operational costs were to be reimbursed at a rate of 50%. After the 1996 deadline, expenses covered by enhanced funding would drop to the lower 50% rate as well. The deadline for enhanced reimbursement was later extended through September 1997.

New York intended its system to meet the requirements of the federal Adoption and Foster Care Analysis and Reporting System (AFCARS). AFCARS requires states to report certain statistics on children receiving foster care and adoption services to the federal Department of Health and Human Services (HHS) or face penalties, starting in 1997. AFCARS compliance was a key goal of the CONNECTIONS system and part of the Request for Proposals (RFP).

The CONNECTIONS system was intended to serve as an important information system to help track the thousands of children in the State's child welfare system. It was designed to address a growing crisis in child welfare in New York, where children were falling through the cracks in the "system". Among its goals were to:

  • improve case decision-making and planning;
  • improve overall tracking of cases;
  • increase accuracy and timeliness of information;
  • provide an opportunity to integrate data across all service systems;
  • provide ready access to case files and resource information;
  • provide supervisory and management assistance in monitoring and evaluating casework;
  • provide more efficient case management at all levels; and
  • meet federal reporting requirements.17

The Department of Social Services (DSS) released the Request for Proposals (RFP) in July 1995. In February 1996, in a rush to meet the original federal funding deadline, DSS awarded contracts to two vendors: ISSC--a subsidiary of IBM--for hardware installation, and Andersen Consulting LLP for software development.18 Together, the original contracts totaled $113.6 million. Five years later, the contracts have grown to over $216 million, only three out of five major components of the system are operational, and users complain that these parts do not work as intended and are unreliable.

Caseworkers say it has created more work for them, rather than assisting them to do their jobs, and as a result, they have less time to spend with children. Only part of the system is operational, and there is a general lack of confidence in the components that are in place. Local child welfare agencies have, therefore, created workarounds and separate systems, and continue to maintain paper files. At an Assembly hearing in May 2000, Marjorie McLoughlin, Executive Director of Cardinal McCloskey Services, a not-for-profit child welfare agency under contract with New York City, summed up her agency's complaints with the system:

"What we have now is a poorly functioning system for some people, at great expense to all people, with aging equipment and with no demonstrable help to even a single caseworker, in the Voluntary Sector, much less to any child or family that we serve."19

Software implementation began in 1996. The system was originally to be comprised of five "releases", which supported various child welfare services. However, implementation was halted in early 1998 when users complained that the largest component, "Release 4", which was supposed to handle case management and fiscal management, did not meet their needs, was time consuming, and had many technical problems. Release 4 was never implemented; neither was Release 5 which was to provide management reports to local child welfare supervisors. Later that year, a State Comptroller audit of the system found weaknesses in the planning, design, development, and implementation of the system, as well as poor controls over change orders.

In response to the audit, the Governor convened a Review and Oversight Panel in January 1999 to review the project and make recommendations for proceeding. The Panel's recommendations included hiring a consultant -- known as a Project Integrator -- to monitor and evaluate fixes to the system being done by State workers and Andersen Consulting. The consultant was also to conduct a reassessment of the entire system to determine whether and how to either fix it, or scrap it and start over. The Office of Children and Family Services, which is now responsible for the project, has also formed various management committees and user groups to involve users of the system in developing the final product.

While most users are generally optimistic about the recent plans for re-evaluating and fixing the system -- and virtually all agree that such a system is urgently needed in New York -- they continue to maintain duplicate manual records and alternative computer systems because they do not believe CONNECTIONS is reliable.

C.     NEW YORK'S CHILD WELFARE SYSTEM

New York's child welfare system serves tens of thousands of children statewide receiving child protective services, preventive services, foster care services, and adoption services. These programs are administered locally by social service districts in 57 counties and New York City. Some local districts contract with private not-for-profit agencies to provide certain services. Unlike many other states, New York has a decentralized system; the State agency serves primarily in an oversight and advisory capacity.

Until January 1998, the former New York State Department of Social Services (DSS) was responsible for administering and overseeing the State's child welfare programs. Effective January 8, 1998, DSS was reorganized into the Offices of Children and Family Services (OCFS) and Temporary and Disability Assistance (OTDA), within a new Department of Family Assistance. Under the reorganization, OCFS is now responsible for child welfare programs, as well as youth programs formerly under the State Division for Youth. OCFS has also assumed responsibility for the implementation of the CONNECTIONS system.

CONNECTIONS is intended to be a single, statewide integrated system connecting OCFS with all 58 social service districts, as well as not-for-profit agencies under contract to provide child welfare services.

D.     FOCUS OF EXAMINATION

The Assembly Committees on Oversight, Analysis and Investigation and on Children and Families focused their examination on the following issues:

  1. Specific to CONNECTIONS: To understand what the problems are with the system, why the system is not working as intended, what the impacts are to children and families, how the Administration plans to fix the system, and the current and expected future costs.

  2. General: To learn from the procurement, design and implementation of the CONNECTIONS system, and, in turn, to apply what is learned to improve and strengthen the Procurement Stewardship Act, and New York's information technology procurement process.

E.     OVERVIEW OF THE STUDY

Much of the research involved in this investigation was conducted in 1999 and 2000 under the leadership of William L. Parment, then-Chairman of the Oversight, Analysis and Investigation Committee. Initial preparation of this report was conducted under his able guidance. In January 2001, Assemblyman Scott Stringer took over as Chairman of the Committee. Along with Assemblyman Roger Green, Chairman of the Committee on Children and Families, Assemblyman Stringer has assumed the task of completing this report, implementing its recommendations, and helping to ensure ongoing legislative oversight of the CONNECTIONS project.

Between the fall of 1999 and the spring of 2000, Oversight Committee staff examined the procurement record and related documents, spoke to State Comptroller and agency personnel, and reviewed various outside reports that cite CONNECTIONS. From initial inquiries and reading through thousands of pages of procurement documents, it became clear that the procurement and implementation processes raised issues that the Committees needed to look at more closely. They decided to hold hearings and make further inquiries.

Joint public hearings were held by the Assembly Committees on Oversight, Analysis and Investigation; Children and Families; and Governmental Operations on May 12, 2000 in New York City and May 23, 2000 in Albany. Testimony was received from various users of the system, including: not-for-profit child welfare agencies; county social services commissioners; unions representing State and county workers who use the system; and representatives from the Administration, the contractors, and the State Comptroller's office. The hearings sought to answer the following questions:

  • What specifically are the problems with the system and how do they impact service delivery?
  • To the extent that CONNECTIONS is not functioning properly, how are programmatic issues and case management problems cited in Comptroller audits and other reports being addressed?
  • How reliable has the CONNECTIONS system been in producing accurate and consistent information?
  • How has the delay in implementation of CONNECTIONS affected various users? What alternative systems are being used in the meantime?
  • Were steps taken in the original procurement process that led to some of the problems with the system today? Could the process have been conducted in a different manner that would have produced better results?
  • Were the contracts entered into in compliance with the 1995 Procurement Stewardship Act? Does the CONNECTIONS procurement offer any lessons on how the Act might be improved?
  • Were there and are there now adequate checks and balances in the process governing contract review and approval and project oversight?

This report brings together key issues and findings identified during the Committees' investigation and the public hearings. Some of the testimony received and documents reviewed are quoted throughout this report.20 Most important is understanding the problems with CONNECTIONS and their impacts on children and families. The report will examine this first, and then will try to answer the question: How did we get here? The discussion then goes back to the beginning to consider issues with the original procurement and subsequent contract management. Finally, fiscal impacts of the system are examined. Administrative and legislative recommendations to address these findings are presented, with the hope that similar problems in procuring and implementing future information technology projects might be averted, and to help address present CONNECTIONS problems.



  1. Source: "1999 Monitoring and Analysis Profiles with Selected Trend Data: 1995-1999", New York State Office of Children and Family Services.
  2. Source: Data from the State Comptroller's office.
  3. "Governor Pataki Announces High Tech Plan to Fight Child Abuse", (Press Release), February 29, 1996.
  4. Ibid.
  5. P.L. 103-66, enacted August 10, 1993.
  6. CONNECTIONS Request for Proposals, Department of Social Services, July 1995, p. 7.
  7. ISSC is now known as IBM Global Services; Andersen Consulting is now known as Accenture.
  8. Written testimony of Marjorie McLoughlin, Executive Director, Cardinal McCloskey Services, May 12, 2000 public hearing.
  9. There were technical difficulties in the transcription of the May 23, 2000 public hearing. Therefore, the possibility of errors in the transcript exists. Every effort was made to quote exchanges around which no question existed. Whenever possible, the written testimony submitted by a witness was used instead.



II.     PROBLEMS WITH THE CONNECTIONS SYSTEM AND THEIR IMPACTS ON CHILDREN AND FAMILIES


This section of the report summarizes some of the key problems identified with the CONNECTIONS system, and how they have impacted children and families and service delivery. It includes issues and concerns described by witnesses at the May 2000 public hearings, as well as problems that the Committees learned of through their own research. On numerous occasions, the Committees reached out to the Office to understand their perspective on these issues and to learn of their plans to rectify the situation. The focus of the issues raised is: are children better off or worse off since CONNECTIONS was initiated?



A.     FINDINGS

  • Finding: Despite the Office's and the contractors' public claims, when pressed, the Administration admits the system doesn't work as intended.

At the Committees' public hearings, representatives of both OCFS and Andersen Consulting touted the successes of CONNECTIONS. It was not until pressed that they admitted what the Administration has been saying for some time privately - that the system is not working as planned.

OCFS Commissioner John Johnson testified that he believes the system is currently working. However, his testimony focused on the parts of the system that are operational, rather than functions that have problems or have not yet been put into production. He maintained:

"[T]he CONNECTIONS system is an essential tool that already is helping us to better protect the children of New York."21

The Commissioner credited CONNECTIONS with reducing New York City's backlog of investigations of child abuse and neglect reports from 31,000 to fewer than 150. He praised CONNECTIONS for improving the amount and quality of information that is relayed from the Child Abuse Hotline to local child protective workers. He also testified that CONNECTIONS has processed over 400,000 reports of abuse or neglect without the loss of a single file. (As will be seen later, many users of the system dispute these claims.)

While admitting that the Office experienced challenges in implementing the system, the Commissioner praised the future capabilities of the system, noting that:

"Today, in fact, we are moving steadily forward in implementing a state of the art computer network that will better protect our children."22

Andersen Consulting's Martin Cole also argued that the system is working:

"…[W]e're proud of the work Andersen Consulting has done to help the state build New York Connections…and I want you to know that it is working and protecting the children of New York.23 …The Connections system is extremely stable. And it reliably processes massive volumes of data, helping caseworkers protect the children of New York."24

The contractor also credits the system with many functions that are not yet available to users. For example, Mr. Cole noted that the system is designed to help meet State and federal guidelines. Yet it is Release 4 -- which has not been rolled out yet -- that contains many of these functions, including tracking State and federal deadlines and producing federally required AFCARS reports. He acknowledged that while Release 4 was delivered by Andersen in October 1997, it was not placed into production, pending an evaluation of the user test results, an assessment of organizational changes needed, and the resolution of user issues and requests for system modifications. An evaluation of the pilot revealed extensive user dissatisfaction, and as a result, the system was never rolled out.

Despite the above positive characterizations, the Administration has admitted elsewhere that the system does not function properly. In June 1999, the Office released a Request for Proposals (RFP) to hire a consultant ("Project Integrator") to reassess the system and determine how to fix it. In this RFP, the Office describes the status of the system:

"A State Panel, established in January 1999 to study the system, determined that CONNECTIONS was incomplete and not performing at a satisfactory level. The findings extended to the hardware, software, documentation, change process, requirements management, system design and the reliability and accuracy of the data."25

Further, the proposal from Maximus, the successful bidder chosen by the Office for its expertise, concluded:

"The CONNECTIONS project is at a critical stage. While all hardware and internal infrastructure has been implemented across the state, less than half of the system's capabilities has been implemented. Functionally, the software supports only the initial acceptance and investigation of allegations of reports of child abuse and neglect….while foster care, adoption, and preventive services programs are supported by the non-SACWIS Child Care Review Service (CCRS). This creates a dual working environment, additional costs, and end-user dissatisfaction. Compounding the existing dual environment, functional and technical issues have been identified within Release 2 that require immediate remediation. As a result, the state is faced with an incomplete federally mandated child welfare management system that is not supported by local districts and voluntary agencies because of its functional and technical deficiencies." 26



  • Finding: The problems created by CONNECTIONS have had a negative impact on children and families.

As described above, the problems with CONNECTIONS range from the software and hardware to the overall implementation of the system. This section of the report details some of these problems. It also describes the potentially serious impacts to children and families caused by these problems.

The crux of the problem is that only 3 out of the original 5 software releases are operational, and those components that are in place require fixes and modifications. As a result many goals of the system have not been met. Brian Wing, now the Commissioner of the Office of Temporary and Disability Assistance, described the problems that CONNECTIONS was supposed to address:

"When the federal government initiated the SACWIS project, virtually everyone agreed that New York desperately needed an improved, comprehensive automated system for its child welfare programs. What we had at the time was a variety of systems, mostly antiquated and labor-intensive, with caseworkers [sic] buried in paperwork. The safety of children was potentially compromised by the lack of quick access to, and exchange of, information, and the State's credibility with federal overseers was low."27

To date, not much has changed. Because of the problems described below, overburdened caseworkers have no confidence in the system. Most caseworkers maintain paper back-up files and have developed cumbersome work-arounds and separate systems to handle what CONNECTIONS was supposed to do. Further, problems such as inaccurate checks of potential child abusers through the Child Abuse Registry potentially put children at risk. Thomas Cetrino, of the Public Employees Federation (PEF), which represents State workers at the Child Abuse Hotline, testified:

"...the veteran members who work at the [Child Abuse] registry are extremely concerned that the accuracy of the clearance process cannot be trusted. If they have no faith in the system, how can the public trust it?"28

Service providers, who generally support the idea of the system, indicate that it is not meeting their expectations. James Purcell, Executive Director of the Council of Family and Child Caring Agencies (COFCCA), which represents most of the not-for-profit child welfare agencies across the state, testified:

"While child welfare service providers understand and support the need for a child welfare tracking and management information system, they have been repeatedly dismayed by the operational difficulties they encounter in the current Connections system."29

While happy about CONNECTIONS' e-mail system, providers more often recognize barriers raised by CONNECTIONS. Some insist that despite these barriers they have been able to serve children as required by law. Others paint a bleaker picture of the direct impact the system has had on service delivery and contacts with children and families. Chautauqua County Social Services Commissioner Edwin Miner testified:

"It should be obvious to state that anything that diminishes or degrades this human contact undermines our capacity to help and further victimizes the innocent. Connections, in its design and implementation, manages to achieve these dubious distinctions by erecting barriers to direct intervention…. The computer terminal competes with face to face contact and often wins."30

Nicholas Scoppetta, Commissioner of New York City's Administration for Children's Services (ACS), also expressed dissatisfaction with the system:

"We're enormously frustrated, so frustrated that we are spending millions of dollars for work-arounds because CONNECTIONS didn't work."31


  1. Problems with Searches and Data in the Child Abuse Registry.

    Several problems were identified with the components of CONNECTIONS used by workers at the State Child Abuse Registry and by local child protective workers investigating allegations of abuse and neglect.

    1. Person search function is not accurate. CONNECTIONS does not always retrieve past reports of abuse or neglect that are in the system regarding an individual. This is in part because the system does not accurately search for various permutations of names of suspected child abusers. According to Child Abuse Registry workers, the prior system could better handle name permutations. This information is critical in investigating subsequent reports of abuse or neglect, and in clearing individuals for jobs working with children.

      In a recent news article, a Suffolk County child abuse investigator described how it is not uncommon for her memory of a prior incident to be more reliable than CONNECTIONS. In one instance, she was assigned to investigate a case of suspected abuse, where the name of the suspected abuser sounded familiar. She typed the name into CONNECTIONS, but its search function came up with nothing. After searching her paper files, she found that the individual had indeed been reported two years earlier. She noted that such incidents are not uncommon:

      "I have investigated a family that I know should be in [CONNECTIONS] but they're not. I will drive up and find that I've been at this house before. We have a lot of new workers and if they go to this system and it says nothing, they don't even know to look for [paper] case records."32

    2. Backlogs of clearances have been traced to CONNECTIONS. Workers report that two types of backlogs have resulted from CONNECTIONS' deficiencies.

      • Backlogs of clearances of prospective foster and adoptive parents and day care workers, which are processed by the Child Abuse Registry, have been tied to problems with the search function in CONNECTIONS. Thomas Cetrino of PEF, testified:

        "There is always a large backlog of "clearances" because of these problems with the CONNECTIONS system. It is not unusual for it to take months for a clearance to be run. Our members at OCFS often receive complaints from people who have not been hired because the employer could no longer wait for them to be cleared by the Child Abuse Registry.33

      • Backlogs of administrative reviews have also been linked to CONNECTIONS. When credible evidence is found to substantiate a report of child abuse, the alleged abuser is entitled to an administrative review of the case by OCFS staff. However, workers report that CONNECTIONS cannot identify or process these cases, creating a significant backlog. As a result, OCFS staff is presently reviewing cases from as far back as 1995.

    3. The system is not able to perform functions required by law. The following problems were identified by workers at the Child Abuse Registry:34

      • The system has never been able to adequately identify or process statutorily required administrative reviews of substantiated cases of child abuse.

      • By law, the subject of an unfounded child abuse report should be removed from the system 10 years after the report is deemed unfounded. Workers at the Registry report that CONNECTIONS does not accurately remove such reports from the system.

    4. The system loses information. Users have found that the system does not reliably record entered information. They therefore feel the need to write down the information before entering it so the information is not lost. This is particularly critical at the Child Abuse Registry, where workers are instructed to write down reports of child abuse before entering them in the system. This backup manual system wastes critical time for caseworkers and is very frustrating. Thomas Cetrino of PEF explained:

      "A few months after it was implemented, the system lost thousands of child abuse reports. Since that time, all reports of child abuse are first entered on paper and then entered into the system…It is possible that after an hour of work, the system will lose the information that has been entered. It is also possible that the system will duplicate the reports on its own. You can never tell from day to day what is going to happen when you enter a child abuse report into the Connections system."35

      These duplicate manual records are in addition to the other manual records needed because the current system is incomplete. For example, CONNECTIONS cannot be used yet for case management and tracking. Therefore, caseworkers enter some information into the old CCRS system, but still must maintain paper files or separate in-house databases for the additional information that CONNECTIONS Release 4 was supposed to track, including federal Adoption and Safe Families Act (ASFA) requirements.

    5. Inaccurate data exists in the system. Several witnesses expressed skepticism over the accuracy of the data in CONNECTIONS. They questioned the reliability of the system as a whole to track children and to serve as a billing system for children in foster care.

      • The system started off with incorrect data. The system is partly based on inaccurate data that was originally entered into other State computer systems, especially CCRS. Since more people will be entering data into CONNECTIONS, the potential for continued inaccuracies is great. Marjorie McLoughlin, of Cardinal McCloskey Services, testified:

        "…New York needs an effective management information system. And that system must be able to maintain internal accuracy and integrity. To date no system that we have ever tried has been able to do this. The legendary Child Care Review Service (CCRS) that has served the Child Welfare System for the past 15 years is famous for its inaccuracy…With every child welfare caseworker in New York entering data [into Connections], we do not even have a prayer of maintaining accuracy, and without accuracy the system is useless."36

      • When incorrect data is discovered, caseworkers are not permitted to correct it in the system. This perpetuates inaccuracies, and may have serious consequences. Examples include:

        • Typographical errors in a name are perpetuated in CONNECTIONS because the system does not allow caseworkers to correct them. This makes subsequent searches less accurate because the system does not recognize variations of a name. Mary E. Sullivan, Executive Vice President of the Civil Service Employees Association (CSEA), testified on behalf of workers in county social service districts:

          "The computer system will not let caseworkers correct typos on the screen. Because of this, it may be impossible to look up a known child abuser if the name was misspelled in any of the forms."37

        • The foster home recertification function initially assigned incorrect recertification dates to foster homes. Although the date problem has since been fixed, agencies are not allowed to correct old, inaccurate recertification dates on the system. They must continue to monitor the old, incorrect dates for some homes as well as the true dates, to ensure the homes have the proper certification and will receive federal funding.


    Impacts to children and families resulting from these data and search problems:

    • Inaccurate searches put children at risk. Perhaps the most alarming and direct consequence of ongoing CONNECTIONS problems is that inaccurate searches and clearances against the Child Abuse Registry continue to place children at risk. Searches in CONNECTIONS for known abusers may still come up with nothing. This could result in an investigation being closed when a child is still at risk, or an agency approving someone as a foster parent who has a history as a child abuser.

      The Agency reported to the Legislature that several fixes have recently been made or will soon be made to improve the search function, and to enable caseworkers to correct data in the system.38 However, at least seven more fixes are needed according to Erie County Social Services Commissioner Deborah Merrifield, who serves on the statewide Steering Committee recently formed by the Office to address problems with the system. Until then, it is impossible to know the accuracy of this vital function. In the meantime, local districts have had to maintain parallel systems to double check whether people reported to them have had prior histories of abuse.

      Commissioner Merrifield described the continued uncertainty faced by caseworkers:

      "Staff report that Person Search works better than March 1999, but exactly how much better is unknown and impossible to determine. If the Search doesn't tell you some information on a child or alleged perpetrator of abuse that actually exists in the system, you can't know that you didn't receive missing information."39

      Workers at the Child Abuse Registry estimate that since July 1996, at best, 60% of clearances given by the Registry have been accurate.40 The workers fear that the safety of children involved with the other 40% may have been threatened.

    • Confidentiality breaches. Confidentiality breaches occur when CONNECTIONS erroneously switches the address of the accused abuser with that of the reporter. This can result in the accused person being sent the report of suspected child abuse with the name of the individual who reported them. It also runs counter to the confidentiality protections the State provides for people who make such reports, and could potentially create a risk to the reporter.

      A related issue has been that the name of the accused abuser and the victim are sometimes switched in the system. Commissioner Miner described such a situation in Chautauqua County and its devastating effect:

      "A young girl was the victim of maltreatment. She was in foster care. She was a success story. She got a job in a day-care center. Everything was great. They had to screen the Central [Child Abuse] Registry. She came up as a perp. They had to remove her from her job. She was humiliated. She was embarrassed. It turns out she wasn't a perp, she was a victim. This girl was devastated. She was trying to heal from this and it just shoved her back into the mess."41

    • Backlogs of clearances impact prospective employees and foster parents, as well as birth parents. Often, prospective employees awaiting a clearance by the Registry have not been hired because the employer could not wait any longer for the clearance to be done. Prospective foster and adoptive parents likewise might give up in the middle of the screening process due to the wait. Further, birth parents who are the subject of a report of abuse or neglect may wait years to receive resolution of their case.

    • Workers waste time reviewing reports that should have been removed from the system (i.e., old unfounded reports). Not only does this slow down the process, but it raises the possibility that people may not be cleared for employment when they should be. It may also cause a child protective worker to conduct an investigation that is not warranted.

    • Caseworkers have to re-enter data from duplicate manual records because the system sometimes loses information entered. This wastes precious time otherwise spent helping families.

      James Purcell of COFCCA described the impact of losing case information to caseworkers in contract agencies:

      "Perhaps the most frustrating occurrence for caseworkers using Connections is the disappearance of case records into cyberspace. When this happens, caseworkers must consult their notes from the beginning of a case and re-enter all the information." 42


  2. Problems with system slowness.

    1. The software is slow and cumbersome. CONNECTIONS was supposed to reduce paperwork and improve caseworker productivity, freeing them up to spend more time in the field. Instead, they find that the screens are slow, information does not flow in an intuitive manner, and many more steps are required to perform a function than in the old system. As a result, for Releases 1 through 3, caseworkers spend more time on the system than before its implementation.

      A computer system analyst with Suffolk County's Department of Social Services, discussed this issue in a recent news article:

      "[CONNECTIONS] was designed more for the convenience of programmers than the users. It doesn't really follow a common-sense thought process."43

      Dr. Russell B. Norris testified about the cumbersome nature of the software, and the experience of the staff of Lutheran Social Services of Metropolitan New York:

      "Each foster home, for example, has a different screen for address entry, phone entry, name, license, etc., and because the system is so slow and unreliable, it takes an inordinate amount of time to process even one re-certification."44

      PEF members at the Child Abuse Registry also complain about the slowness of the system:

      "Under the old system, it took about 15 minutes to enter a standard child abuse report into the system. Today it takes about one hour, and it is possible that after an hour of work, the system will lose the information that has been entered."45

      Commissioner Edwin Miner estimated that from 1994 to 1996 (before CONNECTIONS was implemented), caseworkers in Chautauqua County spent on average 1.8 days per week in the office. The rest of the time was spent in the field. From 1997 to 1999, this number jumped to 3.4 days per week in the office, an increase of almost 100%. He explained the reason for the increase:

      "What are they doing in the office? They're waiting. They're waiting for the screen to come on. They're waiting for the file to come up. They're waiting for the server to come up. They're waiting. They're still waiting. And they're still waiting. We've lost half the caseworker capacity."46

      In March 1998, the Committees on Oversight, Analysis and Investigation and on Children and Families held a joint public hearing on the State's Foster Care System. At this hearing, Commissioner Merrifield testified that as designed, the pilot version of Release 4 was expected to dramatically increase caseworker time in the office even further, rather than cutting it in half as she had hoped. She estimated that in Erie County, time spent on recordkeeping would double from 40% to 80% for direct-care foster care caseworkers if the pilot version of Release 4 were placed into production. This would leave them with only 20% of their time to spend directly working with families and others to move cases along.47 This is part of the reason that Release 4 has not yet been implemented.

    2. Hardware issues also contribute to problems with system speed. The following computer hardware problems relating to system speed were identified:

      • Problems with "Connections-in-a-box". CONNECTIONS users access the system via one of three types of computers. "Deskstations" are personal computers that are directly wired into the network, and are located in agencies that also have network file servers. Laptops are available for dial-in access to the system via a modem, and are intended to be used outside the office. "Connections-in-a-box" (CIAB) machines are personal computers that also access the system via a modem. These are used in small agencies or satellite offices that do not have a network file server.

        The Committees heard numerous complaints about the slowness of the CIAB computers. This is apparently separate from the slowness of the software in general. In late 1999, the Office replaced these CIAB machines and half of the laptops to ensure they were "Y2K-compliant". The new computers included upgrades to the disk and modem, as well as a new CD reader. Despite the upgrades, users are still experiencing problems.

        Diana Farkas of St. Christopher-Ottilie, testified about CIAB and laptop dial-in inconsistencies:

        "CIAB sites have historically been the orphans in this network system. Software updates are always behind schedule, most of the Y2K replacements were received after the New Year and dial-in procedures do not consistently work. Most CIAB sites do not even bother dialing-in anymore, making e-mail ineffective."48

        Commissioner Merrifield also commented:

        "These [CIAB] computers are slow and wait so long for a response to a function performed by a staff member that the computer thinks nothing is going on and shuts down. This means a loss of data inputted and precious time, and creates the need to start the process all over again."49

      • The network is slow. The Committees also learned of other problems encountered on the network at various times, which add to users' frustration. Some complain that as the software and usage expanded, the infrastructure became outdated. Diana Farkas testified:

        "Connection time for work cluster sites can be very slow at times for simple tasks such as logging on and off. Sending and retrieving messages via e-mail can take up to minutes per message depending on the time of day and network congestion. This is time taken away from staff working."50

        Mary Sullivan, representing CSEA, testified that members around the State also complained about the network:

        "The system is down at least twice a month and it cannot be accessed for hours at a time. When it crashes, considerable amounts of work can be lost."51

        It should be noted that at the May 2000 public hearing in Albany, Assemblywoman Susan John, then-Chair of the Assembly Governmental Operations Committee, requested information relating to system performance and help desk activities. At the time of this writing, the Office has not provided this information.

        The Office has indicated it is reassessing the system's hardware infrastructure. It is hoped that future upgrades to the network will adequately anticipate the number of users and volume of data on the system.


    Impacts to children and families due to the slow and cumbersome system.


    • Caseworkers have less time to spend directly helping children and families. Rather than reducing paperwork and increasing productivity, CONNECTIONS has caused caseworkers to spend more time in the office and on the computer. This has reduced the time they spend in the field working directly with children and families.

      The CONNECTIONS functions used by each agency vary, as does the amount of time estimated to be spent on CONNECTIONS at each agency. Commissioner Miner of Chautauqua County had estimated that his caseworkers spend 3.4 days per week, or 68% of their time, in the office. Commissioner Merrifield of Erie County estimated this figure to be about 40%. Marjorie McLoughlin, of Cardinal McCloskey Services, testified that her caseworkers spend between 30% and 50% of their time doing paperwork and entering data into the system. She told the Committees that her agency has been less able to serve the client population as a result of CONNECTIONS.

      "[V]ery soon we really won't see clients more than once. We'll see them, put their name and information into the system, and spend the rest of the time maintaining the system."52

      Commissioner Merrifield testified that there has been disagreement between system users and State officials as to whether CONNECTIONS can free up workers' time, or be time-demand neutral, or use more time. The State has portrayed the system as a time-saver. However, the user community has found that the system requires more time. Commissioner Merrifield stressed that agreement on this issue should become a basic standard for improving the system:

      "Counties strongly believe this is a bottom line requirement. We can accept a system where some functions take more time if some take less time, but on balance, is time-use neutral."53

      The issue of time spent with families is expected to become even more critical as agencies continue to work to meet the new requirements of the federal Adoption and Safe Families Act (ASFA). Because of ASFA's strict time constraints to move children into permanency, it is even more important for caseworkers to work with families to help them achieve positive results in a shorter period of time. Under the law, parental rights may be terminated if reunification is not achieved during this period.

    • Less efficient service delivery. Users have complained that the cumbersome nature of the system has resulted in less efficient service delivery by caseworkers. Much of this can be attributed to the additional time workers must spend doing data entry and clerical work, rather than in face to face contacts with children and families. Thomas Cetrino, representing PEF workers at the Child Abuse Registry testified:

      "[O]ur members who use the system every day believe they did their jobs better and more efficiently with the old computer system, which was primarily developed by State employees, and the manual operations in place at the time."54

      Mary Sullivan of CSEA, agreed that in many cases the system prevents workers from doing their jobs effectively:

      "According to our members, the system frequently crashes, is inefficient and wastes time that should be spent investigating child abuse cases. It has not saved the state any money or improved services in any way."55

      Commissioner Miner of Chautauqua County summed it up:

      "[T]here are no commensurate efficiencies or indirect benefits of this system."56

    • Low employee morale. The additional work imposed on already overburdened caseworkers has caused great frustration, aggravation and concern. As Thomas Cetrino testified:

      "Connections is the most frustrating computer system in the entire State on which PEF members work."57

      While many workers are aware of the State's recent efforts to fix the system, most feel that these efforts are doomed to fail. This has contributed to low employee morale in a service area where high turnover and employee burnout already are serious problems.

      Workers fear that experienced people leaving out of frustration could impact service delivery at the Child Abuse Registry. Mr. Cetrino continued:

      "The problems with the CONNECTIONS system have taken a toll on the people who work at the Child Abuse Registry….Most employees transfer out of that unit as fast as they can get another job. . . . Our most experienced people who work at the registry are looking to leave their jobs, and the loss of these employees will make the problems in that unit even worse as there will be fewer and fewer experienced people to train and help the new employees brought in. We fear that the mission of the Child Abuse Registry could be totally compromised if radical steps are not taken to improve the working conditions there."58 (emphasis added)


  3. Problems obtaining, moving, and repairing CONNECTIONS computers.

    Over 14,000 CONNECTIONS computers and other related equipment was initially provided by the State to local districts, contract agencies, and State workers at the Child Abuse Registry. The equipment was allocated based on the number of caseworkers that were expected to use the system directly. Thereafter, if an agency wanted to expand its operations or give system access to non-caseworker staff (e.g. support staff or financial personnel), it was required to purchase the equipment at its own expense. A description of some of the key computer hardware problems that were identified during the Committees' review follows.

    1. Difficulties purchasing supplemental computers and moving existing equipment. A serious issue in New York City has been the inability of contract agencies to move existing CONNECTIONS equipment or to purchase additional equipment. This equipment was supposed to be available solely through IBM, at agreed upon prices. However, the State put a moratorium on additional purchases of equipment in 1998.

      This has proven detrimental to agencies trying to provide services to families, particularly in New York City where a Neighborhood-Based Child Welfare Services initiative (discussed below) is being instituted. James Purcell of COFCCA testified on this issue:

      "We have been told the state believes that the Connections system is vital to the daily operations of child welfare; yet voluntary agencies cannot get State approvals to make Connections viable. Agencies still cannot move existing equipment, update it, or obtain additional computers."59

      Since the May 2000 hearings, the Office has begun moving forward in the area of equipment purchases and moves. Committee staff has been told that a Request for Proposals (RFP) has been developed for additional equipment purchases, maintenance, and site moves. A contract is anticipated to be in place in early 2001. In the meantime, the Office has been providing users with some old, refurbished CONNECTIONS computers. The Office has also contracted with several other vendors to do installations, site surveys, and moves.

    2. Replacement equipment has been scarce. Agencies have also experienced difficulties in obtaining replacement equipment. Dr. Russell B. Norris of Lutheran Social Services of Metropolitan New York described his agency's difficulties in obtaining replacement equipment following a devastating fire at their headquarters in 1999. For nearly a year following the fire, the agency had no link to CONNECTIONS. OCFS would not provide temporary or replacement equipment. Staff had to carry paperwork to an OCFS office in New York City to enter data into the system, and they did not have access to e-mail.

      After many frustrating months of correspondence with State and ACS staff, Lutheran Social Services finally received replacement equipment recycled from another agency. However, the agency only received half of what they originally had, the software on the machines was not upgraded, and the machines were missing keyboards and mice.60

    3. Delays in equipment repairs and upgrades. The Committees also heard testimony about delays in receiving equipment that had been sent to OCFS for repairs and upgrades.

      Diana Farkas of St. Christopher-Ottilie described the delays experienced by her agency:

      "We had approximately 10 systems that had to be sent to Albany for software reloads. The return is a minimum of 1 month - we've had more than 1 system that has taken up to 4 months. Since not every caseworker has their own computer to begin with this creates a considerable hardship."61


    Impacts of insufficient CONNECTIONS computers

    • New York City providers are unable to meet decentralization requirements. As noted above, a recent initiative to move toward neighborhood-based services in New York City has been hampered by problems with CONNECTIONS.62 While this program got underway after the initial design of CONNECTIONS -- the City's RFP was released in 1998, and contracts with providers were entered into in 1999 -- the State was slow to respond.

      It is clear that such a dramatic change in service delivery would require additional CONNECTIONS hardware infrastructure and computers for multiple locations, as well as software modifications. Further, the Office knew of these needs as early as 1996. However, it is apparent that the Office has been slow to act -- particularly with regard to accommodating equipment purchases and site moves. The 1998 moratorium on additional purchases of CONNECTIONS equipment has impacted the implementation of decentralization by stalling the delivery of neighborhood-based services.

      In some cases, provider agencies are trying to open new offices in the communities they are contracted to serve under the new initiative. However, they have been denied permission by the State to purchase new equipment for these offices. Instead, caseworkers have had to shuttle paperwork back to their agency's main office for data entry, wasting precious time. Agencies also have not been able to move equipment from one location to another as they restructure their operations to accommodate the neighborhood-based service system.

      James F. Purcell of COFCCA testified before the Committees:

      "On a systemic level, the most significant technology problem facing child welfare agencies…is the continuing freeze on approvals for moving and obtaining Connections computers. These agencies cannot complete their moves to their assigned community districts without Connections computers. Their inability to access Connections is an obstacle to implementation of New York City's Neighborhood Based Child Welfare Services Plan." 63

      Marjorie McLoughlin also described the impact to Cardinal McCloskey Services:

      "With the New York City RFP process we have expanded our operations by opening offices in other community districts… We also expanded during that period so we had to move social workers. It took months and months to be able to move the equipment with them, so the movement of the equipment slowed our ability to be able to move into the community districts to deliver services that the RFP mandated."64

      Dr. Russell B. Norris of Lutheran Social Services of Metropolitan New York explained that his agency had received a contract that would move a substantial part of their caseload to Harlem, where they would have to purchase office space. He described their dilemma:

      "[W]e've been told by the Connections system that it would be very unlikely that we could have a direct line into the new offices in Harlem. We're going to have to apparently continue to do our input into the system through our offices here in lower Manhattan which means, again, trucking everything down that needs to be done…"65

    • Agencies have been forced to do without computers for inordinate periods of time. Difficulties obtaining replacement equipment and delays in receiving equipment repairs and upgrades have impacted caseworkers' ability to do their jobs. The lack of equipment creates a tremendous inconvenience for workers who have had to carry paper case files to another location to enter into CONNECTIONS. This takes away from time that could be spent working directly with children and families. Further, workers and administrators unable to access the CONNECTIONS e-mail system may miss important policy notices and other information.


  4. Software problems.

    Many problems relating to the CONNECTIONS software were identified. Too numerous to list in their entirety, some of the key issues raised and their impacts follow.

    1. The system, as implemented, is incomplete. As discussed earlier, CONNECTIONS is only partially implemented. Major parts of the system have not been rolled out -- including Release 4 (the largest component, which was to provide case management as well as fiscal capabilities such as payments and claiming) and Release 5 (management reporting). In addition, CONNECTIONS has not been modified to address system needs that are necessary to meet new statutory requirements.

      An example of such statutory changes is the far-reaching federal Adoption and Safe Families Act (ASFA), and the corresponding State enacting legislation (Chapter 7, Laws of 1999), which require child welfare providers to meet numerous new deadlines and requirements. The State's child welfare information system should be expected to help document and track many of these requirements. However, so far, only a few changes have been incorporated into system "Builds". Other needed ASFA changes have not yet been made, as they mostly relate to case management which is part of Release 4. Further, new federal regulations establishing performance measures required under ASFA will undoubtedly require additional changes to the system.

      The Office has informed Committee staff that State workers use a manual process, involving data from the old Child Care Review Service (CCRS) system, to meet the ASFA requirement for tracking the time a child spends in foster care. This information is then posted to the local districts. Some districts use this data; others track it on their own through databases they have developed or purchased specifically to meet ASFA requirements.

    2. Caseworkers are only using the system for minimal requirements. Because so many functions are not yet working adequately, caseworkers use the system for only the most basic functions, such as electronic mail and word processing. Cardinal McCloskey Services uses the CONNECTIONS foster and adoptive home development module, which only enables them to register and list foster and adoptive parents, and to type home study reports for prospective foster parents. Marjorie McLoughlin, Executive Director of the agency, said that she does not think the staff at her agency understand why CONNECTIONS is needed:

      "…[T]hey see it pretty much as a word-processing system because that's all it's been to them."66

      Workers must still depend on other State databases that are not integrated with CONNECTIONS -- such as CCRS and the Welfare Management System (WMS) - to provide information not available in CONNECTIONS. This requires more time and effort by caseworkers, and involves duplicate data entry. In many locations, workers must log on to at least 2 computers on their desks to access the various separate databases. James Purcell of COFCCA testified:

      "When the State announced the creation of its Connections System, it promised a computer tracking and database that would eliminate the need for the current unreliable Child Care Review System (CCRS). Now, years later, voluntary agencies actually have to maintain three or four separate data systems. Connections must be integrated with local systems to create a system that accommodates the multiple accountability systems in place-notably including ASFA."67

      Commissioner Merrifield stressed the importance of integrated information systems:

      "The public rightly expects DSS to have information from its left hand and right hand to link key information together to effectively protect children." 68

      Not only will linking various State systems help improve service delivery to children and families, but it was one of the federal requirements of SACWIS systems.

    3. Inadequate management reports. CONNECTIONS was originally supposed to provide managers around the State with ad hoc reporting capabilities as part of Release 5. This Release was dropped in 1997 when other fixes and modifications to the system were given a higher priority by the State, and costs started escalating. Today, users are generally not satisfied with the few "canned" reports that are available, and some feel they have lost management reporting capabilities that were available under the prior system.

      The Office has informed the Committees that State staff and Maximus staff are in the process of developing a "data warehouse" that will enable local reporting. This will replace what Release 5 was supposed to do. However, a system to enable local reporting is not expected to be available statewide until the end of 2001 at the earliest. In the meantime, local districts and agencies have been left to their own devices -- at their own expense.

      In New York City, ACS has taken the initiative to expand on the existing canned reports. Among other things, ACS and Andersen Consulting (the original developer of the CONNECTIONS software) designed a separate system for management reporting. Commissioner Scoppetta testified:

      "The State system does not provide local reporting capabilities as part of Connections, but the State has authorized ACS to develop this function on its own." 69

    4. New York City has had to do additional programming to comply with local requirements and to improve operations. According to Commissioner Scoppetta, ACS has contracted with Andersen Consulting for $11 million to enhance the programs available through CONNECTIONS and to develop systems that will meet the specific needs of New York City. This includes developing specific placement functionality, enhancing some of the management tracking functions, and developing a management reporting capability as described above. He concluded:

      "Allowing ACS to review case specific data in this manner will enable caseworkers, supervisors and managers to make better informed decisions. This ability is crucial to the efficient operation of ACS and will greatly enhance the management of ACS operations and services." 70

      While this work appears to fall within CONNECTIONS' original goal of improving management information and decision making, ACS had to do this additional work on its own.

    5. Other specific software problems. In addition to the issues raised above, the Committees learned of many problems relating to the specific software releases already in place (i.e., Releases 1 through 3). Some of these problems are to be addressed in upcoming Builds to be done by Andersen Consulting. Others are being discussed and priorities are being set by the user work groups convened by the Office, and their status is unknown. Still others relate to Release 4, which may be redesigned based on the upcoming reassessment.


    Impacts of software deficiencies

    • The incomplete CONNECTIONS software has slowed the implementation of New York City's Neighborhood-Based Child Welfare Services initiative. Besides the difficulties agencies have encountered obtaining computers (noted above), CONNECTIONS' software deficiencies have also impacted this program. Release 4 of CONNECTIONS was supposed to provide placement functions integral to this new program, which places children in foster homes in the children's own community districts. ACS Commissioner Nicholas Scoppetta testified that in the meantime, ACS has had to contract separately with Andersen Consulting to develop specific placement functionality. His agency is also working with the State to make the placement portion of Release 4 operational sooner than the rest of the module.

    • Providers have been forced to develop alternative computer and manual systems to track information CONNECTIONS does not track.

      • Besides dealing with the programmatic implications of meeting the new ASFA requirements, local districts and contract agencies have been burdened with the added cost of developing additional tracking systems and entering information into them. Agencies are also concerned about potential federal disallowances if ASFA requirements cannot be documented. James Purcell of COFCCA testified:

        "[A]s ASFA compliance monitoring begins we hope that OCFS will bear some responsibility for not having provided promised monitoring capability." 71

      • Providers also continue to maintain their own case management systems and other State systems. This results in duplicate data entry and takes time away from direct casework contacts.

        In some instances, workers have developed work-arounds, both in CONNECTIONS and through the use of paper files, to get past deficiencies in the system so they can continue their work. This wastes time and perpetuates inaccurate data in the system.

    • The incomplete software and inadequate reports impact supervision and decision making. Two of CONNECTIONS' original goals were i) to improve case decision making and planning, and ii) to provide supervisory and management assistance in monitoring and evaluating casework. As implemented, CONNECTIONS has fallen short of these goals because the system is incomplete and does not track all data needed to achieve these goals. In addition, the lack of local reporting capabilities has left supervisors and staff without the tools they had hoped would improve the quality of services and decision making.


  5. Problems with system implementation.

    Following are some examples of inadequacies in the planning and implementation of CONNECTIONS that may have contributed to the problems with the system described above.

    1. Lack of user input. While some users felt they were adequately involved in designing the system to meet their casework needs, others felt their recommendations were ignored by the State and Andersen Consulting. ACS Commissioner Nicholas Scoppetta described the process that was followed:

      "It appears that because of time pressure, New York State rushed the development of a SACWIS and decided to convert a system that had already been developed for another state, rather than create a new system specifically designed for the needs of New York State. The State did not fully consult the local districts in the development of the system, and what consultation did take place did not result in much local input in the initial design of Connections."72

      State and county workers that use the system also complained that they have not been involved in designing and fixing the system. Thomas Cetrino of PEF testified:

      "The problems were compounded when OCFS management did not require the consultant to spend adequate time defining the needs of the system users or familiarizing themselves with the data they were working with." 73

      Mary Sullivan, representing CSEA workers in the counties, had this to say about the latest efforts to fix the system:

      "Unfortunately, we think this effort is another waste of taxpayer money and is doomed to fail. The reason is quite simple. At no time during the planning or implementation of Connections has there been any input sought from the people who actually use the system. CSEA members who work in county social services districts have been aware of problems with the system since its inception, but no one would listen."74

      This lack of user input helps to explain the dissatisfaction among users with Release 4. Because their needs were not adequately considered, the product that was delivered by Andersen Consulting did not represent what the users thought they would be getting, and what, in fact, they needed to execute their responsibilities. As will be discussed in more detail later, it appears that in trying to limit the number of modifications to the Texas system, Andersen Consulting and the State dropped some of the requested changes or "gaps" identified by users as necessary to fulfill State requirements. The heavy involvement of the Governor's office from the beginning, rather than the State agency which is more familiar with the needs of users, certainly affected this result.

      A November 1998 State Comptroller's audit of CONNECTIONS found that system users were not adequately involved in system planning and testing. The audit charged that these weaknesses resulted in delays, user dissatisfaction, and escalating costs. Commissioner Johnson acknowledged the impact of this early lack of user input, noting:

      "The audit report reveals the negative implications of failing to adequately engage system stakeholders and not developing the appropriate management infrastructure. We agree that both of these steps must be taken if the project is to be successful."75

      The Office has acknowledged that it must gain user support in order for the system to succeed. Such a requirement has been documented as vital by a recent study of SACWIS systems in other states.76 The Governor's Review and Oversight Panel, formed in response to the audit, issued recommendations in 1999. Based on these recommendations, the Office has put into place a management structure that is intended to involve users -- at both the front line and management levels -- in improving and developing the system. This structure includes an overall Steering Committee, a Management Committee, and several work groups focused on topical areas. The Committees heard from several witnesses that are pleased with this structure so far. Deborah Merrifield, Erie County Social Services Commissioner, testified:

      "Improvements to the State's project management structure are on the right track and provide for comprehensive input and checks and balances on key assumptions of what is needed and how to meet the need. The increased sensitivity to the needs of the counties is evident in the active role given to counties at all levels in the new project management structure."77

      Despite the positive attitude of some users, the past experiences, low morale and skepticism of others may continue to be a barrier to successful implementation. There is still a feeling among front-line workers that the Office continues to ignore their concerns. The unions representing caseworkers that use the system every day in the local districts and the Child Abuse Registry report that their members are not involved with the recently formed committees and workgroups. And some question whether the Administration is truly interested in hearing about the problems that they are experiencing.

    2. Project scope has kept expanding. Another problem has been that because of poor planning, the goals and the scope of the project have kept evolving. This has made it difficult to manage the project, and has increased the time needed to implement the system. Marjorie McLoughlin of Cardinal McCloskey Services, boiled it down to this:

      "From its inception in the mid 1990's, Connections was intended to provide a consistent, Statewide tracking, claiming and billing system and had it been limited to this objective, we might have a working and useful network. Instead it was decided that a system might be designed and implemented that in fact could be all things to all people." 78

      She believes it is important to scale back expectations to complete the project, concluding:

      "… it is time to recognize that Connections has been from the get go an overly ambitious and extraordinarily costly boondoggle."79

      Chautauqua County Social Services Commissioner Edwin Miner echoed these sentiments:

      "From its beginning, Connections has been far more cumbersome and labor intensive than the awkward and outdated paper system it was supposed to replace. It was not designed with a vision for its interface with human beings. It is neither intuitive nor logical. Finally, it is slow, tedious and potentially fatally inaccurate."80

      Commissioner Merrifield commented that although many of the current priorities were part of the original concept of CONNECTIONS,

      "In many cases, the wrong diagnosis was applied in the development of the system and what the State hoped to achieve."81

      In fact, the formal goals of the system have changed over time. While the initial RFP for the system outlined the basic federal SACWIS requirements -- meeting federal reporting and data collection and integration requirements, and providing more efficient, economical and effective administration of child welfare programs -- the system was gradually expected to do much more.

      In December 1996, a Reform Plan developed by New York City's Administration for Childrens' Services (ACS) anticipated that CONNECTIONS would help to significantly improve operations at the troubled agency. The system was expected to reduce the agency's reliance on 26 different, unconnected computer systems that required a redundancy of paperwork. It was also expected to "empower caseworkers with the tools they need to do their jobs, and create a positive work environment for workers while improving their efficiency and productivity." 82 Additionally, as will be discussed, the Office has invoked the CONNECTIONS system in more recent years as the answer to numerous programmatic deficiencies cited in Comptroller audits.

      The Office has recognized that the goals for CONNECTIONS must be streamlined to get the project under control. In response to the Governor's Panel recommendations, the goals have been revised and improved to reflect user-driven needs, which focus on serving children and families and supporting basic casework practice in addition to fulfilling technical requirements. Among the goals are supporting local flexibility and access to data, creating better quality case records that reflect accurate data, and eliminating unnecessary data entry and forms.

    3. Problems with the Help Desk. The help desk, originally operated jointly by Andersen Consulting and IBM, is supposed to help users resolve hardware and software problems.83 If a call cannot be resolved immediately, a "ticket" is issued and referred to State staff for further action or investigation. In the meantime, users often resort to work-arounds or alternative systems (including paper backup) to get their work done while they are awaiting a resolution. The Committees learned of long delays in resolving problems, and of confusion over what services are available through the help desk. This has contributed to user dissatisfaction, and has forced providers to resort to work arounds until the problems identified can be fixed.

      Dr. Russell B. Norris, Jr. of Lutheran Social Services of Metropolitan New York, told of calling the help desk several times with a hardware problem and being told different things each time. He concluded:

      "So, there seemed to be a great deal of confusion…regarding what kind of services were available and what they could do for us. We find frequently we'll call and we'll be told someone will get back to you, and it may take several days or a week before someone does get back to us. It's a very slow process." 84

      Thomas Cetrino, of PEF, told of Hotline workers' frustration:

      "Our members who called [the help desk] left messages on a machine and, if they were lucky, their problems would be handled weeks later. Meanwhile, our members still had child abuse reports to file and clearances to run. The people needing these services could not wait for the weeks it took Andersen Consulting to solve a problem. Generally, the solution was to file a paper report until the report could be entered into the system."85

      Diana Farkas, Personal Computer Manager at St. Christopher-Ottilie, complained that the help desk is very slow and many staff are inexperienced:

      "Many times staff is not adequately trained or knowledgeable which adds to the amount of time to resolve problems….Turnaround time is slow and tickets are sometimes closed before they are resolved. Technicians are not reporting back to the helpdesk when and what components are repaired or replaced." 86

      OCFS explained to Oversight Committee staff that when a problem requires a modification to the software, the ticket is entered into a database. An OCFS management team sets priorities and decides whether to incorporate these tickets into the next software "Build". As of November 2000, there were 1,038 unresolved tickets, out of almost 4,000 received since the project's inception.87 The large number of unresolved problems further supports user claims that the system does not meet their needs.

    4. Other implementation issues. Following are other issues brought to the Committees' attention which have impacted implementation of the system:

      • The agency initially switched over to the new system (Releases 1 through 3) without adequately testing it. Problems encountered thereafter had to be handled in the "live" system, which presents a more difficult process for making corrections.

      • Release 4 -- the bulk of the system -- was rejected by users in pilot locations and as a result it was never rolled out statewide. A key reason for their rejection is that it had not been adequately tested, nor was their initial input adequately solicited and considered.

      • Schedules for fixing and modifying the system keep getting pushed back for a variety of reasons, frustrating users who see only limited improvements.

      • Training and user manuals have been generally inadequate. Due to high staff turnover, a large number of caseworkers do not know how to use CONNECTIONS. Until they can be trained, they use manual case management systems. The Office has informed the Committees that it recently expanded its training program. (Andersen Consulting was originally responsible for training under its contract. This was later dropped in exchange for additional programming. A $4 million contract with the State University of New York Research Foundation was added in 2000.) An assessment of training was outside the scope of the Committees' investigation and should be independently examined.



  • Finding: Until CONNECTIONS is fixed and fully implemented, the problems it was intended to remedy remain.


  1. Audit recommendations that CONNECTIONS was supposed to address are still outstanding.

    In March 2000, the State Comptroller issued several follow-ups to 1997 audits of the State's child welfare programs. The Office had originally cited CONNECTIONS' future capabilities as solutions to the audit recommendations. For example, the Office had promoted CONNECTIONS' planned ability to generate detailed management reports, and to track information about children in foster care and those freed for adoption, as ways to increase monitoring of State programs. However, these case management and reporting functions are part of the non-operational Release 4 and the "Data Warehouse" that is currently under development.

    In the follow-up audits, the Comptroller noted the continued unreliability of CONNECTIONS, and criticized claims offered again and again by State officials that CONNECTIONS is the "answer" to many of the audit recommendations:

    "Every time there was a problem, OCFS said Connections was the solution….But Connections itself has been a problem. This is about children. If protecting children is important, then solving the problems with Connections must be a priority." 88

    A recurring recommendation in the follow-up audits was that, until CONNECTIONS is fully operational, other steps should be taken to improve monitoring in areas relating to: the Adoption Subsidy Program (audit report 98-F-27), Kinship Foster Care (audit report 98-F-25), and Adjustments to Welfare and Food Stamps Benefits to reflect placements in foster care (audit report 99-F-24). Specifically, the Comptroller recommended the State perform formal monitoring of district compliance through actual district site visits.

    Until such formal monitoring is done by OCFS or its regional offices, it is impossible to know whether State child welfare programs are being implemented as required. Thus, children that are intended to be helped by these programs may not be receiving needed services.

  2. Recent court settlements point to the need for a functioning CONNECTIONS system to correct deficiencies.

    Two recent court settlements cited in the Committees' earlier joint report, LOSING OUR CHILDREN: An Examination of New York's Foster Care System, underscore the need for a properly functioning child welfare information system.

    The first settlement is of a federal class action lawsuit brought on behalf of children in the City's child welfare system, against New York City and State child welfare officials (Marisol A., v Rudolph W. Guiliani). The plaintiffs asserted widespread failures by the City and State to adequately protect and serve children in the New York City child welfare system. Among the charges was that the City's case records were incomplete and did not adequately reflect services that may or may not have been provided. In December 1998, settlement agreements were reached with the City and State. These settlements were to expire in March 2001.

    Under the City settlement, an independent Advisory Panel was created to assess ACS' performance and issue recommendations and timetables for improving services and agency administration. Such efforts continued through December 15, 2000. Several of the Panel's recommendations highlighted areas where the implementation of an up to speed and comprehensive CONNECTIONS system would be particularly beneficial, especially in measuring performance indicators of the child welfare system as a whole, and in monitoring ACS and contract agency staff performance and outcomes.

    The Panel noted in its Final Report that such performance measurements of front line and supervisory practice would be hampered rather than aided by CONNECTIONS, as currently designed:

    "Unfortunately, because of limitations in the State's automated systems, breakdowns [of outcomes and indicators] by worker and unit for contract agencies will not be possible." 89

    The Panel explained the importance of knowing differences in performance at the individual staff level as a critical step in strengthening front line practice in the child welfare system, and concluded:

    "The limitations of existing data systems will no doubt make this a difficult process, but we think that it is well worth undertaking."90

    The State settlement, among other things, required OCFS to:

    • Establish a New York City Regional Office to monitor child welfare services in the City, and any needed corrective actions.

    • Review ACS' child welfare case records to determine ACS' compliance with applicable laws and casework practice, and monitor corrective actions.

    • Use reasonable efforts to implement an accurate and reliable Statewide computer system (i.e., CONNECTIONS) at the earliest practicable date, and continue to use reasonable efforts to correct deficiencies or problems that currently exist or arise in the operation of CONNECTIONS. OCFS is also directed to train ACS workers on CONNECTIONS.

    In January 2001, the plaintiffs went back to the court seeking to enforce the State settlement and to extend the settlement period to ensure that all provisions are met. The plaintiffs were not satisfied with the State's compliance with the settlement provisions, including the requirement to use reasonable efforts to implement CONNECTIONS. In their Memorandum of Law in support of their motion to the court, they stated:

    "Every step of the way, this critically important accountability device has been delayed, mishandled, and mismanaged. Other than the hundreds of millions of taxpayer dollars that have been poured into a non-functional computer information system, the children of New York and the plaintiffs on whose behalf this settlement was negotiated are still without the protections of an adequate computerized state-wide information system."91

    The second suit (United States ex. Rel. Graber v. The City of New York, et. al.), settled in November 1998 by the City and State, alleged that City officials developed a plan whereby caseworkers filed false casework reports on hundreds of children in foster care, without providing the needed services. The settlement required the City and State to pay back $49 million in federal foster care dollars. In addition, it required the City and State to provide detailed information to the federal Administration for Children and Families (ACF) regarding compliance with State and City foster care laws and policies. Notably, once the CONNECTIONS child welfare computer system is finally implemented, the Office is required to provide ACF with a computer terminal so it can access data on foster care cases.

    This appears to be another instance where lack of oversight and incomplete case records have resulted in penalties to the State. Until CONNECTIONS is fully functioning and can help detect fraud and abuse, the State runs the risk of continued exposure to such actions.



B.     RECOMMENDATIONS

Administrative

  • The Office should continue to work closely with the CONNECTIONS user community -- including local districts, contract agencies, and State workers -- to identify system modifications that will address their needs and help them to achieve their mission. The completed system, which originally promised to save caseworkers time, should at least be time-demand neutral.

  • The Committees reiterate their recommendation from their earlier report, LOSING OUR CHILDREN, that the Office should significantly increase its supervision of the local districts to ensure that State programs are being implemented as intended and that children and families are being served. This is especially important in light of the Comptroller's findings that CONNECTIONS has failed to fulfill its role as a tool to aid in State agency oversight.

  • The Committees also recommend that the State Comptroller continue to monitor the Office's efforts to supervise local district operations.

Legislative

  • Until CONNECTIONS is operational, the Office should take interim steps to address Comptroller audit recommendations, and should keep the Governor, Comptroller, and Legislature apprised of these steps. Currently, agencies are only required to file with these entities one report -- due 90 days after an audit is issued -- that shows their efforts to implement audit recommendations. One report often does not present a full picture of an agency's compliance activities.

    Legislation has been introduced (A.5626) to address the need for continued monitoring of agency actions in response to audit recommendations -- not just in the CONNECTIONS case. This bill would require that all audited agencies continue providing 90 day updates to the Governor, Comptroller, and Legislature until all agreed upon recommendations are implemented. It also provides that the Comptroller may do follow-up audits to determine the extent to which recommendations have been implemented.



  1. Written testimony of OCFS Commissioner John Johnson, p. 3.
  2. Ibid, p. 2.
  3. Written Testimony of Martin Cole, p. 1.
  4. Ibid, p. 3.
  5. Project Integrator RFP, June 23, 1999, p. 7.
  6. Maximus Proposal in response to OCFS' Project Integrator RFP, July 23, 1999, p. III-1.
  7. Written testimony of OTDA Commissioner Brian Wing, p. 1.
  8. Written testimony of Thomas Cetrino, p. 3.
  9. Written testimony of James F. Purcell, p. 1.
  10. Written testimony of Edwin J. Miner, p.2.
  11. "Poor Equipment, Software Woes Plague Network", The Daily News, September 5, 2000, p.2.
  12. "Downloading Disasters: How computers hinder state workers trying to do their jobs", Newsday, December 4, 2000, p.A7.
  13. Written testimony of Thomas Cetrino, p.3.
  14. Ibid, p.5.
  15. Written testimony of Thomas Cetrino, p.4.
  16. Written testimony of Marjorie McLoughlin, p.2.
  17. Written testimony of Mary E. Sullivan, p.5.
  18. Source: OCFS' CONNECTIONS Project Quarterly Report for the period October through December 2000.
  19. Written testimony of Deborah Merrifield, p.4.
  20. Written testimony of Thomas Cetrino, p.3.
  21. "Downloading Disasters", op.cit.
  22. Written testimony of James F. Purcell, p.2.
  23. "Downloading Disasters", op.cit.
  24. Written testimony of Dr. Russell B. Norris, p. 2.
  25. Written testimony of Thomas Cetrino, p.4.
  26. May 23, 2000 public hearing transcript, p.192.
  27. March 18, 1998 public hearing transcript, pp. 189-191.
  28. Written testimony of Diana Farkas, p.1
  29. Written testimony of Deborah Merrifield, p.4.
  30. Written testimony of Diana Farkas, p.2.
  31. Written testimony of Mary E. Sullivan, p.3.
  32. New York City public hearing transcript, May 12, 2000, p.70.
  33. Written testimony of Deborah Merrifield, p.6.
  34. Written testimony of Thomas Cetrino, p.1.
  35. Written testimony of Mary E. Sullivan, p.2.
  36. Written testimony of Edwin J. Miner, p.3.
  37. Written testimony of Thomas Cetrino, p.4.
  38. Ibid, p.6.
  39. Written testimony of James F. Purcell, p.5.
  40. Written testimony of Dr. Russell B. Norris, pp.1-2.
  41. Written testimony of Diana Farkas, p.1.
  42. This initiative was originally spearheaded by Assemblyman Green in 1995. He authored legislation (Chapter 83, Laws of 1995) that required New York City to establish at least 3 demonstration projects that would provide decentralized child welfare services in local communities. However, in 1996 ACS decided to implement the program citywide instead, as part of its plan to reform the City's child welfare system.
  43. Written testimony of James F. Purcell, p.2.
  44. New York City public hearing transcript, p.61.
  45. Ibid, p.21.
  46. New York City public hearing transcript, p. 78.
  47. Written testimony of James F. Purcell, pp. 5-6.
  48. Written testimony of Deborah Merrifield, p.5.
  49. Written testimony of Nicholas Scoppetta, p.6.
  50. Ibid, p.6.
  51. Written testimony of James F. Purcell, p.6.
  52. Written testimony of Nicholas Scoppetta, p. 2.
  53. Written testimony of Thomas Cetrino, p. 6.
  54. Written testimony of Mary E. Sullivan, pp.5-6.
  55. "Development of the CONNECTIONS System Supporting Child Welfare Services", NYS Comptroller audit report 97-S-68, issued 11/17/98, p. B-1.
  56. Statewide Automated Child Welfare Information Systems -- SACWIS: An Experience in Technology Transfer, Beth Case and Eugene J. Monaco, Nelson A. Rockefeller College of Public Affairs and Policy, SUNY Albany, May 18, 2000.
  57. Written testimony of Deborah Merrifield, p. 2.
  58. Written testimony of Marjorie McLaughlin, p.1.
  59. Ibid, p.3.
  60. Written testimony of Edwin Miner, p. 1.
  61. Written testimony of Deborah Merrifield, p. 7.
  62. Administration for Children's Services, Plan of Action, December 1996, p. 137.
  63. The Office advised Committee staff that IBM has taken over the operation of the help desk through March 2002, and that the Office plans to eventually merge the CONNECTIONS help desk with a larger one that will handle problems with multiple agency systems.
  64. New York City public hearing transcript, p. 19.
  65. Written testimony of Thomas Cetrino, p.6.
  66. Written testimony of Diana Farkas, p.1.
  67. Source: OCFS SIR Report, 11/3/00.
  68. State Comptroller H. Carl McCall, March 1, 2000 Press Release, "McCall: Lack of Leadership Delays CONNECTIONS Fix; Failed Computer System Continues to Leave Children at Risk".
  69. Final Report, Special Child Welfare Advisory Panel, December 7, 2000, p.30.
  70. Ibid, p.47.
  71. Memorandum in Support of Plaintiffs' Motion for an Order Directing Compliance with Certain Provisions of the Marisol State Settlement Agreement , submitted to the US District Court, Southern District of New York, January 2, 2001.



III.     PROCUREMENT ISSUES


In light of problems and issues raised about CONNECTIONS, the Committee on Oversight, Analysis and Investigation went back to the project's beginning to try to answer the question: How did we get here? This necessitated understanding the procurement process, and the resulting contracts with IBM and Andersen Consulting.

Committee staff reviewed thousands of pages in the CONNECTIONS procurement record and other documents, including a bid protest on file at the Comptroller's office, and requested clarification from the Office when needed. The review sought to answer: Did the agency follow the Procurement Stewardship Act and other laws in letting the CONNECTIONS contracts? If so, did the Act itself contribute to some of the problems which resulted? If it was not let in compliance with the Act, how and why not? Where did the process break down? Does the procurement record clearly disclose steps followed and decisions made in the procurement process, as the law requires? Did these actions lead to some of the problems with the system today? Does the CONNECTIONS procurement offer any lessons on how the Act might be improved?

This section first discusses the State's technology procurement process generally, and then lays out findings relative to the CONNECTIONS procurement.



A.     INTRODUCTION

  1. Background of New York's Technology Procurement Process

    As mentioned earlier, the purchase of computers and information technology, as well as other goods and services purchased by State agencies, is governed by the State Procurement Stewardship Act (the Act)92. This law, originally enacted in 1995, was modified and extended in June 2000. The awarding of the CONNECTIONS contracts, which began in late 1995, was governed by the Act.

    A basic principle of the Act is to ensure fairness, transparency and objectivity in conducting State procurements. It is also intended to promote competition and avoid favoritism among vendors. The law states: "The objective of state procurement is to facilitate each agency's mission while protecting the interests of the state and its taxpayers and promoting fairness in contracting with the business community." 93

    While lowest price is the basis for awarding contracts for commodities or goods, the 1995 Act established the principle of "best value" for purchasing services, including information technology and computer hardware. Best value procurements seek the offerer which optimizes quality, cost and efficiency, and give agencies greater flexibility in selecting a proposal which best meets their needs.

    To help ensure the fairness and transparency of State procurements, agencies are also required to maintain a Procurement Record identifying -- with supporting documentation -- the decisions made and approach taken in the procurement process. The National Association of State Purchasing Officials' (NASPO's) Principle and Practices suggest that "the documentation ought to be sufficient to allow competing bidders or offerors, the public and the press, and auditors the basis for the award decision….After award, the procurement file should contain a record sufficient for a reader (perhaps some considerable time later) to follow the course of the transaction, especially as to the method of evaluation and basis of award."94

    Based on provisions of the Act, State agencies have established procedures for conducting best value procurements, including issuing Requests for Proposals (RFP's) and evaluating proposals received. Many of these procedures are detailed in Guidelines issued by the State Procurement Council.95 The process described below, which DSS set up to determine best value in the CONNECTIONS procurement, is similar to that which State agencies typically use for other best value procurements.96

  2. The CONNECTIONS Procurement Process

    DSS issued an RFP in July 1995 to potential vendors. This document laid out the minimum technical specifications that vendors were required to meet in order to be considered responsive. It also set forth general criteria against which the proposal would be evaluated, and set a maximum score that could be achieved. DSS established a Technical Evaluation Committee (TEC) first to identify detailed evaluation criteria and document them in the procurement record before offers were received, and then to evaluate, score and rank the proposals received based on these criteria. The scoring of these individual criteria were also documented in the procurement record and summarized and tabulated in charts. Such an arithmetic scoring system enables a potentially subjective assessment to be quantified, and lends credibility and objectivity to the process. Proposals were to be ranked based on the total points received.

    The agency also set up a Financial Evaluation Committee (FEC) to evaluate the price proposals and determine which offers were within the competitive range established before offers were received. Proposals were to be ranked based on total costs, including certain additional costs the FEC determined would be incurred by the State to implement each proposal.

    The TEC and FEC were comprised of agency personnel with expertise suitable to make such evaluations. These committees operated separately from each other; neither committee knew the issues raised or rankings given to the proposals by the other committee until the end of the process.

    After offers were received and evaluated, the TEC and FEC were to submit reports including the rankings and their recommendations to an over-arching Selection Committee. The Selection Committee included management level personnel from DSS, plus non-voting representatives from the Division of Budget and the State Comptroller. It was charged with evaluating the recommendations of the TEC and the FEC and making a final recommendation to the DSS Commissioner.

    The process originally established for the CONNECTIONS procurement is a fair characterization of how other agencies are to conduct best value procurements. However, some of the changes DSS made in the CONNECTIONS procurement may have had an impact on the problems that subsequently occurred in the design and implementation of the CONNECTIONS system. Therefore, lessons to be drawn from the way the process was followed in this case have implications on other procurements in the State. As will be seen below, in numerous instances the established process broke down, in disregard of the intent and spirit of the law.

    Some of these issues were the subject of a bid protest filed with the Comptroller's Office by Unisys Corp. Unisys was a partner with BDM Technologies Inc., one of the bidders in the CONNECTIONS procurement. It should be noted that currently there is no statutorily required process for vendors to follow in contesting the fairness of a procurement and resulting award. NASPO recommends that procurement statutes require a procedure for resolving protests, complaints and contract disputes.97



B.     FINDINGS RELATING TO THE CONNECTIONS PROCUREMENT

  • Finding: The evidence indicates that operating principles of the law were violated, while in other instances, deficiencies in the law allowed for irregularities in the procurement process.

    Examples of violations and deficiencies: The Committee discovered the following examples of instances where the agency bypassed provisions of the law.

    1. Fundamental changes were made in what the State asked companies to deliver, and how the State judged what they offered.

      Midway through the procurement, the Administration made several critical changes to the RFP and the evaluation criteria, in apparent contradiction of the law. These changes created a moving target for vendors to respond to, and raise questions about whether they may have favored the selected vendors.

      Without conducting a new procurement, the agency decided to consider a split award, after having solicited bids for a single vendor. The original RFP requested vendors to propose a single, integrated hardware/software solution. After receiving proposals from four prime contractors in September 1995 (Andersen Consulting LLP, AT&T Global Information Solutions, BDM Technologies, Inc., and Integrated Systems Solutions Corp. -- ISSC -- a subsidiary of IBM), DSS requested Best and Final Offers (BAFOs) from only these four offerers in January 1996. The Best and Final RFP requested the vendors to make three distinct proposals:

      • an integrated solution (Full Project);
      • a new proposal for the hardware and office
        automation component only (Component 1);
      • and a new proposal for the software
        application only (Component 2).

      The second change was that the agency altered several key evaluation criteria, after initial proposals were received. Among the changes were: adding a seventh criterion for an end-user prototype evaluation, changing the weights of the scores for each of the criteria, changing the competitive range, and adding new criteria to be considered by the Selection Committee in the final round.

      As will be described next, each of these changes to the procurement were so far-reaching that they appear to have violated the principles and legislative intent of the Act. Example 3 will discuss other irregularities in the procurement process established by DSS.

      1. Splitting the award should have required a new procurement. State law is silent on the term "Best and Final Offer". According to the Comptroller's Office, over the years the term has come to refer to State agencies' practice of approaching vendors that have already submitted proposals to ask them for their very best price. Accordingly, vendors are not intended to be given an opportunity to submit totally new technical proposals. The law does allow that: "Where provided in the solicitation, state agencies may require clarification from offerers for purposes of assuring a full understanding of responsiveness to the solicitation requirements." 98 (emphasis added) In the CONNECTIONS case, however, vendors were asked to submit new technical proposals for the hardware and software components, not just clarifications of their existing proposals or a lower price for the combined system.

        Further, the principles of fairness and competition inherent in the Act were compromised, at least in appearance, by changing the requirements midway through the procurement. For example, in limiting the second round of proposals to only the original four offerers, vendors that may have been able to bid on only one component of the system (e.g., the hardware, consisting mostly of personal computers) were excluded from competition. There is also the appearance that the decision to split the bids, which was made after seeing the original proposals, may have favored the selected vendors.

        The Comptroller's office had expressed its concern that the change from a single vendor to two vendors between the RFP and the BAFO was so great that it altered the procurement and was inconsistent with the law. In a September 30, 1996 letter to DSS, the Comptroller's office stated:

        "We have serious concerns that the change from an integrated solution to a bifurcated solution: (i) altered the essential identity or main purpose of the contract; and (ii) may have limited competition. As a result, we have serious reservations as to whether the process undertaken by DSS satisfies the requirements of section 163 of the [State Finance Law], with respect to best value procurements."

        If the agency wanted to consider separate proposals for hardware and software, in addition to a single vendor approach, then a) a new RFP should have been issued requesting separate proposals; and b) the new RFP should have been distributed to all potential vendors, not just the four who had bid on the original RFP. This would have potentially opened up the procurement to more competition and a fairer process, and might have resulted in a lower cost to the State.

      2. Evaluation criteria, against which proposals were judged, were changed after seeing the original offers. First, evaluation criteria and their associated scores changed between the RFP and the BAFO. Then, the Selection Committee substituted its own limited evaluation criteria in making the final recommendation. Whether or not this is consistent with the intent and the letter of the law was also the topic of a lawsuit involving another DSS procurement that was pending at the time of the CONNECTIONS procurement (Transactive Corp. v. D.S.S., 236 A.D.2d 48), and will be discussed below. Another issue raised is whether these changes unfairly benefited ISSC and Andersen at the expense of other offerers.

        • Evaluation criteria changed between the original RFP and the Best and Final RFP

        The 1995 Procurement Stewardship Act required that an agency:

        "shall document in advance of the receipt of offers, the determination of the evaluation criteria, which whenever possible, shall be quantifiable, and the process to be used in the determination of best value and the manner in which the evaluation and selection shall be conducted."99 (emphasis added).

        This requirement was a key element of the statute's overall purpose of ensuring fairness and avoiding favoritism. The underlying concern was that once an agency knows what vendors are offering, evaluation criteria may be manipulated to help a favored vendor, or at least create the appearance of impropriety.

        The general idea of this provision is that an agency determines the criteria up front, and locks them away in a vault until after bids are opened to ensure that none are changed to benefit one vendor. The law also requires that the RFP disclose the minimum specifications that must be met, the general manner in which the evaluation and selection shall be conducted,100 and the relative weight of the cost criteria and the technical criteria to be considered by the agency.101 However, as described below, DSS subsequently changed the CONNECTIONS evaluation criteria, and the requirements of the RFP, in January 1996, after it had evaluated the first round of offers.

        DSS disclosed 6 general technical criteria and their maximum point scores in the original RFP. The total maximum score possible was 110 points. In addition, DSS established a competitive range of 12.5% for the Total Fixed Price Offer. This meant that only technically qualified bidders whose offers fell within 12.5% of the lowest priced technically qualified offer would be considered further. Based on these criteria, the only qualified bidder within the competitive range was AT&T.

        After the Best and Final RFP was released, several changes were made. First, a seventh criterion--End User Prototype, was added by the agency. This involved inviting a team of eventual end-users of the system to see a demonstration of each proposal. The new criterion was worth an additional 15 points. Thus for the Full Project proposal, the maximum score increased from 110 to 125 points. The maximum scores for Component 1 and Component 2 proposals became 100 and 125 points, respectively. Further, the scores for the seven individual technical criteria for each proposal were also re-arranged, giving them different weights.

        The BAFO RFP also changed the competitive range for the Component 1 and Component 2 proposals. The Component 1 competitive range was defined as all technically acceptable proposals within 5% of the lowest fixed price offer. The Component 2 competitive range became all technically responsive proposals within 20% of the lowest fixed price offer. The competitive range for the Full Project remained at 12.5%.

        These changes had the effect of placing in the competitive range additional vendors who had been excluded by the original criteria due to their higher price offers. Such a fundamental change after receiving the first round of offers creates the appearance that the competitive ranges may have been changed to benefit one or more vendors. The possibility that this action affected the fairness and competitiveness of the procurement adds to the argument that a new procurement should have been done.

        • Selection Committee established its own separate criteria for evaluating the proposals

        Besides the changes in evaluation criteria, the Selection Committee further muddled the evaluation process. The procurement record indicates that ultimately, the Selection Committee abandoned the elaborate (and quantifiable) scores and recommendations of the TEC and FEC in favor of its own limited criteria. This begs the question: Were these criteria chosen after the second round of bids were received to ensure that ISSC and Andersen Consulting would win the award?

        Because more than one bid fell within the Best and Final competitive ranges, the Selection Committee decided to conduct a "cost/benefit" analysis of these proposals, as allowed in the RFP. The RFP does not define the elements of the cost/benefit analysis. However, Procurement Council Guidelines issued at the time describe a recommended approach for combining Technical and Financial Evaluation Results that involves adjusting the rankings of the offerers' financial proposals to reflect value added by technical and qualitative features of their proposals.102

        The procurement record shows that rather than looking at additional technical features of each proposal, in conjunction with the TEC and FEC scores and recommendations, the analysis only focused on four elements, two of which were not previously disclosed as evaluation criteria in the RFP or BAFO RFP (i.e., #2 and #4):

        1. Single vendor vs. multiple vendor approach
        2. Transfer of existing software technology vs. development of new technology
        3. End-user prototype score
        4. Minimizing state costs

        The effect of this change was to nullify the arithmetic, objective scoring system originally established by DSS to determine best value. It was replaced with a more subjective approach that raises serious questions as to 1) whether the State got the best value, and 2) whether the procurement was conducted fairly.

        • The Transactive Case

        The legality of DSS' changing the evaluation criteria was a serious issue in the CONNECTIONS procurement. The resolution of the issue is best understood in conjunction with a second major DSS information technology procurement which was occurring virtually simultaneously with the CONNECTIONS procurement. That second procurement was DSS' award of an "electronic benefits transfer" (EBT) contract to Citicorp in February 1996.

        The CONNECTIONS and EBT fact patterns were substantially the same. In each case, DSS established evaluation criteria, issued an RFP, received offers, changed the evaluation criteria, and then asked the original offerors for another round of offers, which the agency called "best and final offers." In each case, a losing vendor filed a lawsuit challenging the contract award, in part, because DSS illegally changed the evaluation criteria. The losing vendors also filed protests with the Comptroller's Office , asking it to disapprove the contracts, for the same reason.

        DSS took the position that the language of SFL 163(7)--"in advance of the receipt of offers"-- did not require an agency to set the evaluation criteria before the first round of offers, but rather only before the last round of offers. In between, DSS argued, an agency could change evaluation criteria as often as it wanted. The procedural histories of the two cases were somewhat tortuous, but ultimately DSS won acceptance of its general legal position on changing evaluation criteria. In the EBT case, the Comptroller and Appellate Division ruled that an agency may change the evaluation criteria after the first round of offers. Transactive Corp. v. Dept. of Social Services, 236 A.D.2d 48 (3d Dept. 1997) 103; In re Bid Protests With Respect to EBT Services Contract No. COO7589, 9/13/96 letter from OSC to DSS, p.10.

        The Comptroller's Office acceded to DSS' legal argument that evaluation criteria may be changed in both the EBT and CONNECTIONS cases. However, at the same time that OSC was approving the EBT contract, it was balking at approving the CONNECTIONS contract. CONNECTIONS' change from an integrated contract to an bifurcated contract was just too much. As noted earlier, the Comptroller had "serious reservations" that the change altered the essential identity of the contract, and may have limited competition. Ultimately, the Comptroller approved the CONNECTIONS contracts not as a best value procurement, but rather on an "emergency" basis (see Example 2 below).

        In the 2000 negotiations to renew the Procurement Stewardship Act, then Committee Chair Parment took the position that changing the evaluation criteria after the first round of offers was not what the Legislature had intended originally.104 In order to achieve the purpose of ensuring fairness and avoiding favoritism, the court's Transactive decision needed to be corrected. To that end, section 163(7) of the renewed Act was amended to now require that evaluation criteria must be established "in advance of the initial receipt of offers" (emphasis added).

      3. The fundamental changes made by the agency help explain why vendors do not know how they will be judged. Potential vendors should be afforded the opportunity, up front, to know how their proposals will be evaluated. Making vendors aware of what is expected of them can help better ensure a truly competitive procurement, and can hopefully avoid misunderstandings between the vendor and the State after contract award. It might also encourage more businesses to participate as offerers, thereby increasing competition. And, it should help ensure bids that are more responsive to the State's needs.

        The way decisions are made now by the Administration, vendors are often in the dark as to what evaluation criteria are being used, and whether or not they are changed. As Martin Cole, Managing Partner with Andersen Consulting, testified:

        "I would like to say that I trust the system, but I do not know that they don't change the rules. I don't know what the rules are to begin with, often times."105

        Mr. Cole agreed that it is possible that the rules for evaluating proposals might be created after the proposal is submitted to an agency. This was certainly true in the CONNECTIONS case.

    2. At the eleventh hour DSS claimed the procurement to be an emergency. This action went beyond the emergency exception allowed in the law.

      The law defines an "Emergency" as "an urgent and unexpected requirement where health and public safety or the conservation of public resources is at risk."106 It further provides that: "Procurements made to meet emergencies arising from unforeseen causes, may be made without a formal competitive process and shall only be made under unusual circumstances." 107

      "Emergency" under the statute allows for a departure from the ordinary procurement rule of lowest price or best value. It is intended, therefore, to be used under limited circumstances. In the CONNECTIONS procurement, DSS seems to have gone beyond the intent of the law in invoking this emergency exception.

      The CONNECTIONS procurement began in July 1995 with DSS' release of the RFP as an ordinary, non-emergency procurement. By August 1996, it was becoming increasingly apparent that the Comptroller's office was reluctant to approve the contracts because DSS had bifurcated the award without a new procurement, and probably violated the Procurement Stewardship Act. According to the procurement record, it was not until September 26, 1996, 14 months after the procurement began, that DSS invoked the "Emergency" exception to justify its attempt to award the contracts to ISSC and Andersen Consulting.

      According to the Comptroller's office and Procurement Council guidelines, emergencies should be identified by an agency head or designee in advance of the procurement, and then certain steps that would be required in a competitive procurement are waived. In the CONNECTIONS case, the agency began the procurement as a competitive procurement, and at the eleventh hour deemed it an emergency. No steps were officially waived.

      The two arguments DSS gave for the emergency were: 1) the deadline for enhanced federal funding was fast approaching (originally the deadline was September 30, 1996 -- but this was extended to September 30, 1997 in August 1996, before DSS declared it an Emergency); and 2) the crisis in child welfare administration, culminating in the tragic death of Elisa Izquierdo in November 1995, which necessitated an improved system for tracking children. The agency knew of both of these situations with sufficient time to have avoided declaring an emergency.

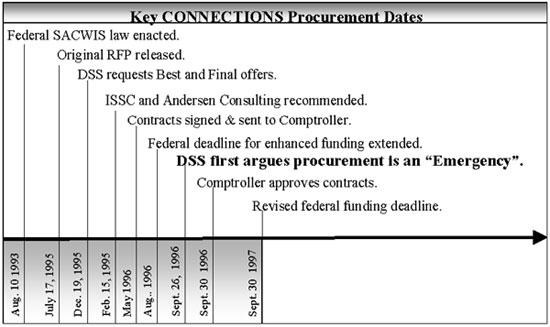

      Key CONNECTIONS Procurement Dates

      Although the federal law regarding SACWIS requirements and federal funding was enacted in August 1993, New York's RFP was not issued until almost 2 years later. The delay may have in part been due to the change in administrations in 1995, however, this transition should not justify an emergency situation. In fact, Procurement Council Guidelines repealed in 2000 stated: "An agency's failure to properly plan in advance which then results in a situation in which normal practices cannot be followed does not constitute an emergency."108 It is interesting to note that in July 2000 the Procurement Council revised its guidelines and dropped this condition from the emergency provision.109 NASPO has also established principles and suggested practices regarding emergencies, which state, in part, instances where an emergency may be invoked:

      "In addition to threats to life and property, an emergency may include circumstances such as a delay in transportation or an unanticipated volume of work. It should never include a situation created by poor planning on the part of using agencies."110

      DSS' other argument for an emergency procurement -- i.e., the crisis in New York's child welfare system -- also was known to the State agency and the public for some time. There is no overstating the fact that serious problems in child welfare existed at the time of the CONNECTIONS procurement; some of these problems continue today. Children had been languishing in foster care since the 1980s. The length of stay of children in foster care had been consistently above the national average. Tragic reports of children, previously known to the system, who were subsequently victimized, were not new. Further, many of the antiquated, unreliable state systems that were in place in 1996 had been in place for some time.

      A key reason for the Committees' examination of the problems associated with CONNECTIONS is to determine what, if any, additional negative impacts the system has had on children and families, and to try to alleviate these problems. However, there was nothing unique about circumstances in September 1996 that justified the agency's bypassing New York's competitive bidding statute.

      Declaring this procurement an emergency was not consistent with statutory intent. The agency declared an emergency at the eleventh hour when it appeared the Comptroller would not otherwise approve the contracts because they did not comply with the legal requirements for a normal competitive procurement. A main concern for the State Comptroller in considering an emergency was the potential loss of $40 million in enhanced federal funding if the contracts were not approved. Furthermore, the Comptroller was faced with the dilemma that much of the work was already completed on the contracts while his office was reviewing them. (see Example 5 below)

      NASPO warns that creating emergency procurements in situations that are not, in fact, emergencies, is one method used by agencies to circumvent procurement laws and rules in order to obtain a preferred brand of an item or to avoid the competitive process. Even the appearance of such circumvention can undermine the credibility of, and public confidence in, the State's procurement practices.111

    3. Irregularities in the procurement process established by DSS to determine best value led to a series of management overrides and miscalculations that drove the award process.

      As mentioned above, DSS had established Technical and Financial evaluation committees (TEC and FEC) to evaluate the technical and financial proposals. Pursuant to the RFP, the TEC and FEC were to make recommendations to the Selection Committee, which in turn was to make its recommendation to the Commissioner "based on the evaluation submitted by the TEC and FEC".112

      Both the original RFP and the BAFO RFP further stipulated that if in the cost ranking, other price offers were not within the competitive range of the lowest price offer, then price would be the basis of selection.113 If more than one proposal was within the competitive range, then the Selection Committee would perform a cost/benefit analysis which would provide the basis of selection. As described earlier, this should have included adjusting the rankings to reflect additional technical features of each proposal.

      Ultimately, it appears that, in addition to the changes in evaluation criteria mentioned earlier, the Administration consistently ignored or overrode the recommendations of the TEC and the FEC. Described below are 3 examples where the established procurement process broke down. Reasons for such actions should be disclosed clearly in the procurement record. Here, key decisions and their rationale were missing from the procurement record, violating the principle of transparency and the intent of the statute. As a result, doubts remain as to the fairness and objectivity of this procurement.

      1. Recommendations resulting from the Original RFP were bypassed. For the first round of offers, which were evaluated in November 1995, the TEC committee ranked BDM first, with AT&T a close second. According to the TEC report, both Andersen Consulting and ISSC needed to make substantial changes to be recommended. 114 The FEC Committee found that only the AT&T proposal was within the competitive range.115 Based on the methodology in the RFP and the original evaluation criteria, AT&T would therefore have been the selected vendor.

        There was no original Selection Committee Report in the Procurement Record. After repeated requests by the Committee, the Office did produce a draft report, dated November 15, 1995. This report, consistent with the TEC and FEC findings, supported an award to AT&T. A final version of the Selection Committee's report, and documentation of the decision to reject the recommendation of AT&T, are both missing from the Procurement Record. It is not clear from the Procurement Record who recommended rejecting AT&T and requesting Best and Final Offers, and who approved this idea. Rather, this information had to be pieced together from other documents reviewed by Committee staff, primarily affidavits included in the bid protest file obtained from the Comptroller's Office (discussed further below).

        From these documents, it is apparent that the recommendation to reject the Selection Committee's proposed award to AT&T and instead request split bids was made by George Mitchell -- DSS' Deputy Commissioner for Systems Support and Information Systems. Mr Mitchell became chair of the Selection Committee on November 15, 1995. The affidavits show that in part, his recommendation was made because of an understated number of computers and sites set out in the original RFP, and in part because Mr. Mitchell was concerned that one vendor would not be able to complete the whole project in time to receive enhanced federal funding. What is not clear is whether other factors were involved in Mr. Mitchell's recommendation, and more importantly, who made the final decision to proceed with it. It is disturbing that such a key decision and who made it are not reflected in the official record.

      2. Recommendations resulting from the BAFO RFP were changed, then ignored. For the second round of offers, which were evaluated in February 1996, there were two versions each of the TEC and FEC reports with differing recommendations. These reports were prepared only days apart and with no explanation as to what drove the committees to change them.

        The TEC made recommendations for each of the three proposals requested. In its February 9 report, the TEC recommended the Full Project be awarded to AT&T; for Component 1 (hardware) , either AT&T, BDM or ISSC were recommended; and for Component 2 (software) , BDM was recommended. The TEC chose BDM for the software proposal because BDM's software was to be completely customized for New York (unlike the other proposals which were based on transfer systems) and would therefore better meet Department needs.

        In its February 15 report, the TEC changed its recommendation for Component 2 to AT&T, highlighting instead AT&T's proposed additional training resources. The fact that AT&T's software was based on a transfer system was not mentioned. In both reports, the TEC recommended against Andersen Consulting for either Component 1 or 2, saying there would be major negative impacts if Andersen was paired with any other vendor. This was based on Andersen's use of Novell Netware for the operating systems and systems management and security tools, instead of Microsoft Windows NT, which the other vendors proposed. Windows NT was being recommended as the Department's standard, but was not included in the RFP specifications.

        There were also two versions of the FEC report. On February 12, the FEC recommended awarding the Full Project only, warning:

        "[the FEC] does not recommend two awards. The FEC believes that the risks outweigh the benefits in a 2 award situation. The Department will incur higher costs under the 2 award scenario. The inherent difficulties with coordinating project management and technical issues with two contractors may create negative costs for the Department."116

        For the Full Project, there were two offers in the competitive range, BDM and ISSC. The FEC recommended awarding the Full Project to the offeror with the highest technical score. This would have been BDM. The report did note that if the decision was made to split the award, it should go to the offerers with the highest technical score for each Component within the competitive range.

        On February 14, the FEC revised its report. While still recommending the Full Project, the FEC softened its language against splitting the award. It also revised its computation of offers within the competitive range. This resulted in more offers being considered. Again, the FEC recommended that if there was to be a split award, it should go to the offerers with the highest technical score for each Component within the competitive range.

        If the Selection Committee had combined the second TEC and FEC recommendations, the Full Project should have gone to BDM. If the project was split, Component 1 should have gone to BDM or ISSC (both had the same technical score), and Component 2 should have gone to AT&T, which ranked #1.

        However, the Selection Committee's February 15, 1996 report indicates that the Selection Committee ignored the recommendation of the FEC to award the full project, and likewise ignored the recommendation of the TEC against Andersen Consulting. The Selection Committee instead opted to do a cost/benefit analysis, basically wiping the slate clean concerning technical scores. It is not clear who was responsible for this decision, but the possible influence of the Governor's Office in overriding these recommendations (described below) calls into question whether the TEC and FEC's roles really meant anything.

        The Selection Committee report also shows that it instructed the TEC to contact all the offerers and inquire as to whether their proposed systems could be changed to accommodate the use of Windows NT. In response, the report says that all offerers indicated that their proposed systems already utilized or could accommodate this change. 117 The result of the change was to reduce Andersen's negative impact from high to medium. Oversight Committee staff did not find any record of these inquiries or responses in the procurement record, nor any estimate of the cost such a change would require for any of the proposals, including Andersen Consulting's proposal. This appears to be another example of management override in the decision-making process.

        It is impossible to know what kinds of problems would have been encountered if another vendor or vendors were selected to build CONNECTIONS. But it is apparent that the TEC and FEC had foreseen some of the potential problems that later came true. It is also troubling that the record shows changes in the TEC and FEC recommendations just days apart, without any documented explanation or additional analysis to support the changes. It gives the appearance that the Selection Committee, or others, may have influenced these changes. The Selection Committee should have documented its reason for straying from the established procedure in making its recommendation. Based on a review of the procurement record, such explanation was not documented.

      3. A technical error affected the recommendation of the Selection Committee. As described earlier, the cost/benefit analysis focused on only 4 criteria. Not only does this approach not consider the quantitative TEC and FEC scores, but one of the criteria in the cost/benefit analysis -- Minimizing State Costs -- did not consider all costs to the State. Specifically, it only included depreciation and interest costs added to the offerers' proposals. It did not include the additional in-house costs the State would incur to implement each offerer's proposal (interface costs, network circuits, and operational support), as previously determined by DSS.

        This technical omission had a significant impact on the Selection Committee's decision. The Selection Committee's analysis found that the combination of ISSC for Component 1 and Andersen Consulting for Component 2 had the lowest cost to the State, totaling $33 million.118 (It is interesting to note that the next closest proposal was BDM for the Full Project, with a State cost of $33.7 million. In hindsight, the difference of $700,000 is miniscule compared to the additional costs the State has incurred to date.) When Oversight Committee staff re-calculated the estimate to include the in-house implementation costs, ISSC was paired instead with AT&T as the lowest cost combination.

    4. The Procurement Record is not in compliance with the law and does not accurately reflect decisions made.

      State law requires that "A procurement record shall be maintained for each procurement identifying, with supporting documentation, decisions made by the commissioner or state agency during the procurement process."119

      As part of its review, the Oversight Committee requested and received the official Procurement Record from the Administration. Committee staff reviewed many boxes of information--involving thousands of pages of documents including vendor proposals--that were made available by the Offices of Temporary and Disability Assistance and Children and Family Services. The official record provided by the agency did not include documentation of change orders and contract amendments made subsequent to contract award. This made it difficult to get a clear picture of the entire procurement to date. Committee staff instead reviewed these documents at the Comptroller's office.

      As discussed throughout this section, key decisions in the procurement were missing, rendering the record incomplete, and in violation of the law.

      Some examples of missing documents include:

      • The transcript and documentation of an August 1995 ex-parte meeting held between then-Acting Commissioner Brian Wing and IBM representatives to discuss the CONNECTIONS procurement (see 6. below).
      • As there was no Procurement Integrity Officer, there were no reports filed about this meeting with IBM (see 6. below).
      • The original report of the Selection Committee from November 1995, recommending AT&T as the successful bidder on the original RFP (for an integrated hardware/software solution).
      • Documentation that this recommendation was rejected, and by whom, and the reason for the rejection.
      • Documentation of the decision to request Best and Final Offers.
      • Record of contacts with vendors by the TEC during the BAFO evaluation to discuss their ability to accommodate the Microsoft Windows NT operating system.
      • Documentation of the reasons the TEC and FEC changed their recommendations just days apart.
      • Documentation of the reasons the Selection Committee ignored the TEC and FEC recommendations.
      • Contract amendments and change orders.

      One goal of the Procurement Stewardship Act is to help ensure that the State's procurement process is a transparent process: key decisions should be available for public scrutiny, thus reducing the chances for fraud or favoritism. In other words, the procurement record should stand alone. In the CONNECTIONS procurement, this was not the case. Because of these missing documents, key questions about the process and its fairness remain unanswered.

      It should be noted that contract amendments and change orders must now be included in the Procurement Record, due to amendments to the Procurement Stewardship Act proposed by then-Chairman Parment during the 2000 renewal of the Act.

    5. Work began on the project before approval by the State Comptroller, a pattern which continues today.

      State law requires that "before any contract made for or by any state agency…shall be executed or become effective, whenever such contract exceeds fifteen thousand dollars in amount, it shall first be approved by the comptroller and filed in his office…" 120 The rationale for the law is, in part, to have an independent assessment of the legality of the procurement process before New York State tax dollars are committed in the form of a contract. The CONNECTIONS procurement illustrates how State agencies widely disregard this provision of law, devaluing the approval process.

      Although the original contracts between DSS and Andersen Consulting and ISSC were dated March 18, 1996, they were not signed by DSS and the vendors until May, 9, 1996. Federal approval was received in June 1996, and Office of the State Comptroller (OSC) approval was not granted until September 30, 1996. Despite the missing approvals, work on both contracts began months earlier in disregard of the law.

      In March 1996, DSS began purchasing IBM equipment off another state contract, at a cost of $5.48 million, for the purpose of CONNECTIONS. On May 16, 1996, DSS gave ISSC contingent binding approval to begin installing equipment under the pending CONNECTIONS contract, subject to Comptroller approval. Andersen Consulting also began work in April 1996, before their contract was finalized.

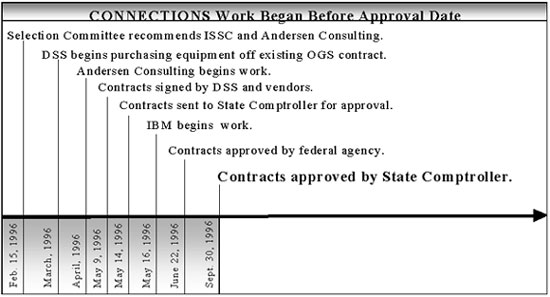

      CONNECTIONS Work Began Before Approval Date

      The early work done by IBM and Andersen Consulting virtually locked the State into continuing with these contractors, for better or for worse. Because substantial work was done before the contracts were approved, and the original federal funding deadline was fast approaching, it made it more difficult for OSC to disapprove the contracts.

      This pattern of preempting Comptroller review continued with the related change orders and contract amendments. For example, the first amendment to the Andersen contract, at a cost of $28.5 million--an increase of 76%--was submitted to OSC on August 27, 1997. At the time it was submitted, $23.5 million of the work was already done by the vendor. In addition, OSC felt added pressure to approve the amendment because enhanced federal reimbursement would only be available for invoices paid no later than September 30, 1997, the new deadline.

      The problem has continued as late as 1999, with the contract for the Project Integrator, a consultant brought in by the Administration to reassess CONNECTIONS. Maximus was selected as the successful bidder for this contract in September 1999, pending formal approval by OSC. The contract also had to be approved by the Federal Department of Health and Human Services. Final federal approval was received on March 30, 2000, and OSC approval was granted on April 10, 2000. Yet Maximus began work in the Fall of 1999.

      At the Albany hearing, Assemblyman Parment observed that it appears that the agency regularly preempts the Comptroller review process, presenting a fait accompli to OSC. This leaves OSC with a choice of approving the agency's actions, after the fact, or denying payment to a vendor which has already delivered goods or services. First Deputy Comptroller Carl Carlucci agreed with this representation, noting that OSC has to deal with this kind of problem on a regular basis, with the CONNECTIONS procurement being a particularly large example. He noted:

      "It's not what we want. It's not what we expect. But again, this contract is larger, and more complex, and raises issues of how well it is managed and coordinated. And to some extent…we find ourselves in a position where in order to keep this project going, because we have made the commitment, we were playing catch-up, to try to review the actions of the agency."121

    6. The agency did not have a Procurement Integrity Officer as required by Executive Order.

      Executive Order No. 189 -- "Limiting the influence of lobbyists on the State agency procurement process" -- requires that reports be made to an agency's Procurement Integrity Officer (a) by agency personnel who are involved in the contracting process and who have contact with any employee or agent of a proposer, and (b) by any proposer of any similar contact. 122 The Procurement Integrity Officer is an individual designated by each agency head to be responsible for ensuring the observance of agency procedures for preventing improper lobbying influence.

      Executive Order No. 189 was designed to effectuate State policy that:

      • "the award of State procurement contracts shall be based solely upon the merits of the competing proposals."

      • "the State procurement process be protected from improper influences by lobbyists in order to ensure that the contracting process is fair and equitable."123

      This furthers the goal of the State's procurement law to ensure all competing vendors in a procurement have access to the same information, so that the playing field remains level, no one gets an unfair advantage, and the selection process is fair, not only in fact, but also in appearance. Executive Order No. 189 attempts to reduce the chance that a vendor will receive information that others do not have access to, thereby biasing the award process.

      In the CONNECTIONS case there clearly was contact that should have been reported and recorded. In August 1995, after the RFP was released but before proposals were due, Acting Commissioner Brian Wing convened a meeting requested by ISSC to discuss the CONNECTIONS procurement. No other bidders were present. This meeting was later disclosed to the other bidders, and became a subject of the bid protest filed by Unisys on the award to ISSC and Andersen Consulting.

      Despite repeated requests by the Committee for reports to DSS' Procurement Integrity Officer during the CONNECTIONS procurement, the agency failed to produce any reports. Shortly before the Albany hearing, the Committee was informed that the Office had recently appointed a Procurement Integrity Officer. According to Commissioner Johnson at the Albany hearing, this individual began serving in that capacity the week of May 22, 2000. Prior to that there had been no Procurement Integrity Officer at the Office. Thus, from at least 1995 through May 2000, the agency was not in compliance with Executive Order No. 189, which was designed to detect and prevent improper contacts and lobbying by firms with proposals before the agency.



  • Finding: Ultimately, the record is unclear as to who was responsible, and accountable, for many major decisions in the CONNECTIONS project. What is clear is that the Governor's office played a critical role in key decisions that led to problems that exist today.

    Numerous documents related to the procurement, through the year 2000, reveal direct involvement by the Governor's office in key decisions and project management relating to CONNECTIONS.

    1. Early involvement of the Governor's Office in the procurement process.

      As discussed earlier, it is not clear from the Procurement Record who made key decisions in awarding the CONNECTIONS contracts. This information had to be gleaned from affidavits submitted in response to the bid protest filed by Unisys. According to these documents, final decisions on awarding the CONNECTIONS contracts to Andersen Consulting and ISSC were made by George Mitchell, an appointee of the Administration, rather than then-Acting DSS Commissioner Brian Wing. Mr. Mitchell had previously been involved in several large technology procurements in other state agencies. On November 16, 1995, Mr. Mitchell was appointed Deputy Commissioner for Systems Support and Information Services for DSS. Commissioner Wing stated in his affidavit:

      "In early October I was requested by the Governor's Office to accept the reassignment of George Mitchell from the Division of Criminal Justice Services in anticipation of his appointment as the Department's Deputy Commissioner for Systems Support and Information Systems….Upon Mr. Mitchell's arrival he assumed complete control of the Department's SACWIS procurement and related SACWIS development." 124

      In fact, Mr. Mitchell became involved in CONNECTIONS even before his appointment was official. On November 15, 1995, he became Chair of the CONNECTIONS Selection Committee. According to his affidavit, he made key decisions which were not documented in the Procurement Record:

      "I was lead executive and made the decision, later ratified by the Committee, to pursue a Best and Final Offer and in the development of the notice letter [to vendors] of December 19, 1995 and chaired subsequent vendor meetings and evaluation/award processes." 125

      Mr. Mitchell was also the driving force in recommending the split bids in the Best and Final RFP:

      "…I recommended that the Best and Final notice require bidders to submit their revised overall proposals along with separate sub-proposals for Phase I and Phase II. This approach would allow the Department to award Phases I and II of the program to either one vendor or to different vendors."126

      Ultimately the Selection Committee, led by Mr. Mitchell, recommended awarding the contracts to ISSC and Andersen Consulting. The procurement record does not indicate who the Selection Committee report was sent to and who signed off on it. This information is also not included in the affidavits. What is clear is that Commissioner Wing had little to say in the final decision. It appears as if the Governor's Office and the Division of Budget played a stronger role in the decision than the Commissioner. Mr. Mitchell described the process:

      "I notified Commissioner Wing of the Selection Committee's decision and made presentations regarding our decision to the Governor's Office and the Division of Budget. Upon appropriate discussions with these bodies, we entered into negotiations with the selected Offeror."127

      Commissioner Wing confirmed his lack of involvement in the procurement. In fact, he described his role in the decision-making process as "ministerial":

      "Although I continued to receive briefing materials on SACWIS developments, Mr. Mitchell (and Larrey Nickles, his successor) and I have had a clear understanding that my responsibilities regarding SACWIS would be ministerial and informational. Accordingly, when I received the recommendation of Mr. Mitchell and the CONNECTIONS Selection Committee to award the SACWIS contracts to Andersen Consulting and ISSC, I ministerially ratified their selections based on my confidence in the abilities and impartiality of such individuals."128

      Without clear responsibility, there can be no accountability. This is a concern in the CONNECTIONS case, where it has been difficult to ascertain who is accountable for the cost-overruns and the fact that the system does not work as intended. What is clear is that it was an appointee of the Governor's office who claimed responsibility for the decisions that overrode the quasi-scientific, arithmetic methodology of the Technical and Financial Evaluation Committees. The end result was a procurement based less on clear, discernable factors, and more on factors that were constantly evolving -- sometimes with little apparent rationale or supporting documentation.

    2. Recent involvement of the Governor's Office in project implementation.

      After the procurement, it appears that the Governor's Office was less directly involved in the early stages of project implementation during 1996-1998. At least, such involvement is not apparent in records made available to the Committee. However, in response to a stinging November 1998 State Comptroller audit, the Governor's Office convened a special review Panel--external to DSS--to evaluate problems with the system and make recommendations on how to proceed. Clearly, the Executive saw the project drifting and took back the helm.

      In March 1999, the Panel issued recommendations which included, among other things, appointing an internal Project Manager who would report to the Governor's Office. The Panel also recommended competitively contracting with an outside consultant, or "Project Integrator", to provide quality assurance, help manage the contractors and state workers developing the system, and assess whether to modify the existing software or start over. Both recommendations were implemented by the Administration.

      The outside consultant is under contract with OCFS, but reports directly to the Governor's Project Manager. In fact, the Committees learned that OCFS had only a non-voting role in evaluating and selecting the successful bidder, Maximus. Instead, the Evaluation Committee was headed by Project Manager Zachary Zambri, who reports to the Governor's Office of State Operations. It is clear, therefore, that not only did the Governor's Office intervene to try to get the project back on track, it continues to be heavily involved in the project.

    3. Who is accountable?

      It is not necessarily inappropriate for the Governor's Office to be involved in a project of this size and complexity, particularly given the problems that exist. In fact, the current involvement of the Executive has been helpful in getting the project back on track and responding to users' needs. However, it is essential that the Administration make known who is responsible and why. This will help answer questions about the project that can be traced back to the procurement (e.g., the decision to split the award), in the hopes of avoiding similar problems in future procurements. Unfortunately, the procurement record leaves unanswered even the most basic question: Who was responsible for making the final decision in the procurement?

      Despite the ongoing involvement by the Governor's Office, no one in the Administration today can speak to the entire history of the project. Anticipating this problem due to high turnover among project staff and the restructuring of the agencies, the chairs of the three Assembly Committees sent a letter to the Director of the Office of State Operations before the May 2000 hearings. They made it clear that the hearings would include a comprehensive discussion regarding the project history and management, and that they "hope and expect that the Administration's representatives at the hearing will be able to fully speak to these issues."129

      At the Albany hearing, Commissioners Wing and Johnson, and Project Manager Zambri, appeared together to answer the Committees' questions. While collectively they answered many questions, they could not answer some very fundamental ones. In particular, they could not provide clarification on decisions made in the procurement process, the reports issued by the TEC and FEC, and even details of the first amendment to the Andersen contract worth $28.5 million. This is troubling as these are areas that appear to be linked to problems with the system today.



C.     RECOMMENDATIONS

Administrative

  • Potential vendors should be afforded the opportunity, up front, to know how their proposals will be evaluated. Making vendors aware of what is expected of them and what the agency deems important can help better ensure a truly competitive procurement, and can hopefully avoid misunderstandings between the vendor and the State after contract award. The recent statutory change requiring that agencies not change evaluation criteria after the receipt of initial offers hopefully clarifies the issue first brought up in the Transactive case. Agencies should also disclose in the Request for Proposals (RFP), to the maximum extent possible, the detailed evaluation criteria that will be used to select the successful vendor.

  • Executive Order No. 189 -- which requires each agency head to designate a Procurement Integrity Officer to receive reports of contacts between agency personnel and vendors -- should be followed and enforced by the Executive. This Executive Order was intended to preserve the integrity of the procurement process by preventing improper lobbying influences.

  • Documentation of contacts that are required to be reported to the Procurement Integrity Officer should be made part of the relevant procurement record.

Legislative

  • A formal mechanism should be established in statute so bidders have a right to challenge what they think is an unfair procurement. The statute should set forth the broad outline of the bid protest process, and require the Comptroller to implement the statute.

  • The statute should require that, except in extraordinary circumstances, agencies must disclose in the RFP the detailed evaluation criteria that will be used to select the successful vendor.

  • Executive Order No. 189 should be codified in statute.

  • The Emergency provision of the statute should be strengthened. This may be done in several ways, which are not mutually exclusive:

    • As previously recommended by the Assembly, codifying the language of the Procurement Council Guidelines that stated that an agency's failure to properly plan in advance does not constitute an emergency.
    • Requiring that an Emergency procurement be declared by the Governor, rather than a management-level designee in an agency.
    • Adopting language from Chapter 116, Laws of 2000, amending section 3-0301 (2) of the Environmental Conservation Law relating to construction emergencies, to, among other things, clearly express the limited nature of such procurements.

  • Legislation is needed to address the problem that State agencies proceed with implementing contracts that have not yet been approved by the Comptroller. One approach is to establish some mechanism to ensure that an agency does not preempt Comptroller review by accepting delivery of goods or services before a contract receives the required approval.

  1. State Finance Law, article 11.
  2. State Finance Law section 163 (2).
  3. State & Local Government Purchasing Principles & Practices 1997, 5th edition, National Association of State Purchasing Officials, p.68.
  4. The State Procurement Council, established pursuant to section 161 of the State Finance Law, is charged with establishing guidelines concerning state procurement. Such guidelines do not carry the weight of statute or regulation, however the Administration often maintains that agencies follow them as if they did.
    (See also footnote 110 below)
  5. As part of the Committee's broader examination of the procurement process, Committee staff have examined the procurement records of a number of other contracts, at DSS and other State agencies.
  6. State & Local Government Purchasing Principles & Practices 1997, op. cit., p.94.
  7. State Finance Law section 163 (9) (c).
  8. State Finance Law section 163 (7).
  9. Although the individual evaluation criteria developed by an agency can be very specific, they are only required to be disclosed generally in the RFP. The RFP usually focuses more on technical specifications, rather than on how they will be evaluated.
  10. State Finance Law section 163 (9) (b).
  11. Procurement Council Guidelines, Section 7 (V) (B) (4) (d).
  12. The Court of Appeals affirmed the Transactive decision on standing grounds, without reaching the merits of the evaluation criteria issue. 92 N.Y.2d 579 (1998).
  13. Chairman Parment's view was colored by a 1994 joint investigation by the State Attorney General and State Inspector General of DSS procurement practices. Their report was highly critical of changing evaluation criteria and found that best and final offers should be used only to get a better price, and not to change technical criteria. Report of Investigation Concerning Computer Procurement at the New York Department of Social Service, and Related Matters, issued 12/28/94, pp.56-57.
  14. Albany public hearing transcript, May 23, 2000, p. 268.
  15. State Finance Law section 163 (1) (b).
  16. State Finance Law section 163 (10) (b).
  17. State Procurement Council Guidelines section 4 (G).
  18. This action occurred shortly after the Administration refused to codify this guideline as part of the modification and extension of the Act. The Assembly had wanted to strengthen the emergency provision of the Act by adding this provision. The Administration argued in this case that the Guidelines are suggestions and are not supposed to be enforced like law. In other words, they did not want to enforce this provision.
    (See also footnote 96)
  19. State & Local Government Purchasing Principles & Practices 1997, op. cit., p.63.
  20. Ibid, p.97.
  21. CONNECTIONS RFP, section 8.4, p.164-165.
  22. CONNECTIONS RFP, section 8.11, p.170.
  23. TEC Committee Report, November 22, 1995.
  24. FEC Committee Report, November 14, 1995.
  25. FEC Committee Report, February 12, 1996, p. 3.
  26. It should be noted that Andersen was the only vendor not already using Windows NT or partially using Windows NT.
  27. Selection Committee Report, p.11.
  28. State Finance Law section 163 (9) (g).
  29. State Finance Law section 112 (2) (a)
  30. Albany public hearing transcript, p. 23.
  31. Executive Order No. 189, paragraph IV(B)(6).
  32. Ibid, preamble.
  33. Brian Wing affidavit submitted to the State Comptroller, July 22, 1996, paragraph 9.
  34. George Mitchell affidavit submitted to the State Comptroller, July 22, 1996, paragraph 2.
  35. Mitchell affidavit, paragraph 7.
  36. Mitchell affidavit, paragraph 11.
  37. Wing affidavit, paragraph 9.
  38. May 8, 2000 letter from Assemblymembers Green, John and Parment to Mr. James Natoli, Director, Office of State Operations.



IV.     CONTRACT MANAGEMENT AND ADMINISTRATION


A necessary outgrowth of the Committee's examination of the CONNECTIONS procurement was to understand the process by which vendor contracts were negotiated and implemented and the Office's management of the project as a whole. The goal was to gain further insight into how some of the problems with CONNECTIONS arose, and to learn from past mistakes to avoid them in future technology procurements.

The Committee's inquiry involved an extensive examination of the original contracts with ISSC and Andersen Consulting, related change orders and contract amendments, and planning documents submitted to the Federal Department of Health and Human Services. Meetings and discussions with representatives of the Administration, State workers, the Federal Government, and the Comptroller's Office were conducted. In addition, several witnesses at the public hearings discussed project management issues they had encountered first hand.


A.     FINDINGS

  • Finding: The State agency failed to adequately manage the contracts and project implementation.

From the start, the Financial Evaluation Committee (FEC) warned DSS that hiring two vendors and placing the State in the role of project coordinator was a risky and potentially costly endeavor. As a result, the FEC recommended against awarding the project to two vendors. This position supports the belief held by many that one contract with one vendor is easier to enforce than multiple contracts, where lines of responsibility may be blurred.

In hindsight, the FEC's predictions have proven all too true. First, contract costs have almost doubled with no end in sight. Second, the State has become an intermediary between two vendors, making it difficult to hold either accountable. Third, a lack of commitment by the administration to provide adequate staff resources dedicated to the project has resulted in yet another consultant being hired to fill the State's role and regain control. There was also a general lack of clarity in the contract requirements--particularly for the software application--that created misunderstandings between the State and the contractor when the product was delivered. The result was confusion and delays, and possibly costly change orders.

The State Comptroller's audit of CONNECTIONS noted the following deficiencies in project development and implementation:130

  • System users were not adequately involved in the design and testing of the system. As a result, the system is not working as intended, it does not meet casework processes, practices and policy, and there is widespread user dissatisfaction.

  • In order to meet Federal funding deadlines, tests of system design were not always completed. As a result, problems that should have been discovered during testing were not found until the system was placed into production.

  • Agency procedures for monitoring project progress and contract completion were deficient or lacking.

  • Improvements in agency controls were needed to ensure that change order requirements were provided as efficiently and effectively as possible, at fair prices, and services paid for were not covered by the original contracts.

  • The Comptroller concluded that unless changes were made in the implementation of CONNECTIONS, there was a substantial risk that the project would not be successfully implemented, jeopardizing $120 million in federal funds.

In an October 1999 follow-up audit, the auditors found that the Office had implemented many of the audit recommendations, including convening stakeholders and improving controls. But, since few changes have been made to the system since 1998, it is too early to tell what the end result will be.

The Administration recognizes some of these past mistakes. Project Manager Zachary Zambri testified:

"When looking at the decisions that were made along the way, each and every one was well intended and seemed to make sense at the time. However, with the benefit of hindsight, we realize that numerous problems resulted from decisions that were made to meet a schedule that would maximize federal reimbursement."131


  • Finding: The contract and amendments negotiated with Andersen Consulting contributed to current problems with the system.
  1. The contract does not reflect what was asked for in the RFP.

    The RFP specified that the CONNECTIONS procurement was to result in a fixed-price contract with specific hardware and software deliverables. The RFP did allow that if the State altered the scope of work, causing an increase or decrease in the contractor's effort, it would negotiate with the contractor to arrive at a price adjustment and actions to be taken.

    Under the negotiated contract price of $37.5 million, Andersen Consulting was to provide a SACWIS system-- known as CAPS--which it had developed for Texas' centralized child welfare system, plus a fixed number of days' work (5,448 days) to modify it to fit New York's needs. On its face, it appears that the contract called for a specific product at a fixed price. However, a question that was not directly addressed was: what if the specified number of days were not sufficient for Andersen to adequately tailor the system to meet New York's needs?

    According to Andersen's financial proposal: "Our Best and Final price offer reflects our assumption that the State will agree to work with us to limit modifications to only those essential changes which can be delivered with approximately the effort included in the proposal. This equals 1,406 days for SCR Intake, 2,596 days for Case Management, and 1,446 days for the Financial Management initiatives. We believe that this effort is more than adequate to make the necessary modifications to CAPS to meet your requirements. Any non essential changes or enhancements identified during the pilot or statewide rollout would be deferred until the system is in production statewide."132

    The negotiated contract does provide for payments for ongoing application software maintenance based on hourly rates.133 This provision opened the door for further scope of work changes.

  2. The first change order changed the agreement to a time-and-materials basis.

    It turns out that DSS and Andersen severely underestimated New York's requirements and the changes that would be needed to make Texas' state-administered system work for New York's decentralized operation. Shortly after the contract was signed, DSS and Andersen convened a group of users from around the State to review the Texas system and identify "gaps" between what the users perceived they wanted and how the base software operated. A total of 811 gaps were identified. The work involved to incorporate all 811 changes far exceeded the allotted 5,448 days, so the State reduced the number of gaps to be addressed to 326, reflecting only those items DSS deemed most critical.134 The work effort involved to implement these 326 items, plus additional requirements to conform to changes in State law and to meet unique needs of New York City, still far exceeded the original 5,448-day limit. The excess work then became the basis of a 1997 contract amendment totaling $28.5 million.135

    Martin Cole, Managing Partner at Andersen Consulting, testified at the Committees' hearings about the extent of the work involved in this first amendment:

    "The application development work effort increased more than five fold, from fewer than 5,500 work days to more than 28,000 work days."

    This amendment notably changed the agreement from a fixed-price contract to one based on time-and-materials. According to the amendment: "Actual effort spent over and above the 5,448 person-days will be billed separately to the State by Andersen…" 136 The amendment specified hourly billing rates for time spent to perform the work. It also provided that any additional scope changes after the initial release of CONNECTIONS would again be covered by the contract's application software maintenance provision, on a per-hour basis.

  3. The original contract did not include changes required by State law.

    The first amendment included, among other things, programming to ensure the system is in compliance with New York State's Elisa's Law (Chapter 12, Laws of 1996). This law made significant changes to procedures used by the State Central Registry of Child Abuse and Maltreatment (Child Abuse Registry) including the length of time reports to the registry must be kept, access to confidential records, and other statewide policies and procedures.

    DSS knew that Elisa's Law would require changes to CONNECTIONS as described in the RFP. Although the original proposals were already being evaluated at the time Elisa's Law was signed, the impact of the new law certainly could have been, and should have been, considered at the time of contract negotiations. The National Association of State Purchasing Officials (NASPO) has stated regarding post-contract changes: "In no case should a vendor be promised before award that the performance requirements will change in its favor after the contract award. Additionally, solicitation performance requirements should not be changed during contract performance except through an authorized change order to the contract, and only where the change does not materially alter the nature of the contract, and could reasonably have been within the contemplation of the parties at the time it was awarded." 137

    Elisa's Law was enacted on February 12, 1996, shortly before the vendors were selected and contract negotiations began. The original contract with Andersen Consulting was not signed until May 9, 1996, and was not approved by the Comptroller's office until September 1996 -- six months after Elisa's Law was enacted. All along, the State and Andersen knew that additional work would be necessary to integrate Elisa's Law into the Texas system, but the State failed to notify the Comptroller's office of the pending contract increase.

    Although the parties knew about Elisa's Law, the final contract amendment was not drafted by Andersen until December 1996. This was submitted to the Comptroller on August 27, 1997 -- 18 months after the law was enacted. It appears that Andersen had been working on the needed changes for some time before that, however, because 95% of the work requested by the State was completed by the time the contract amendment was submitted for approval. The cost to incorporate Elisa's Law was $5,467,472,138 an increase of 15% over the original contract.

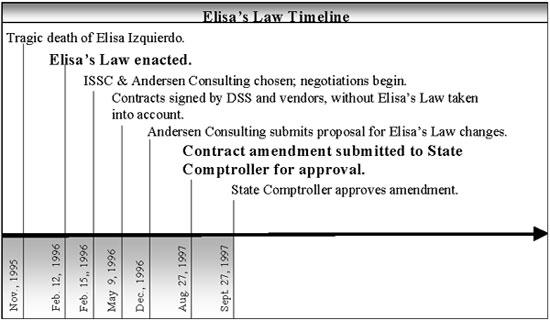

    Elisa's Law Timeline

    This work could have been part of the original contract negotiations, and hence, the work could have begun earlier. At the very least, the agency should have assessed the impact of Elisa's Law up front as soon as it could be determined. Then it could have put the Comptroller's office on notice that a change order increasing the contract pending before it would be coming. Not providing such a courtesy to the Comptroller creates the appearance that the agency was not forthright.

  4. Subsequent change orders show that the State and Andersen still underestimated the amount of work needed to meet New York's needs.

    Although amendment #1 included 326 of the gaps between the Texas system and New York's needs, this represented only 40% of the gaps identified by users during the design and planning stage. This contributed to user dissatisfaction with the system; many have said that the system delivered does not reflect what they thought they were getting.

    Further, problems with Texas' software were carried forward by Andersen into New York's system. Despite early visits to Texas by New York State officials to learn about problems Texas encountered in implementing the Andersen software, the Comptroller's auditors found many of the same problems persist in New York's system.139

    The Comptroller's audit has called into question whether some of the work billed under amendment #1 should have been covered by the original contract:

    "We found that OCFS officials had not designated anyone to be responsible for ensuring that tasks performed by Andersen under the change order were not included in the scope of the original contract. Consequently, OCFS has no assurance that the State has not been charged more than once for the same tasks."140

    In response, Commissioner Johnson acknowledged the shortcomings of the change order process, and promised that revised procedures would be implemented. The October 1999 follow up audit, however, found they were only partially implemented.141 The Office has indicated that Maximus has assumed the role of evaluating proposed change orders, their prices and the goods and services received.

    In 1999, in accordance with the Governor's Review Panel's recommendations, the Office convened major stakeholders and system users to identify critical Release 2 and 3 fixes needed to make the parts of the system already in place functional. In early 2000, several contract amendments were proposed totaling $34 million, bringing the contract total to over $100 million. While some of the work involved was new, much of it was intended to eliminate significant "work-arounds" that child welfare caseworkers had developed out of necessity because the system still did not meet their needs.

    Despite the significant additional work being performed by Andersen, the system will still not be complete when they are done. Release 4, the biggest part of the system, is still not operational, and the Office does not yet know how much effort and money will be involved in completing it.

  5. The current system does not provide federal reports, a requirement of the RFP.

    As designed, CONNECTIONS was supposed to produce biennial reports to the federal Department of Health and Human Services (HHS) on key foster care and adoption statistics. This was a key requirement of the RFP, and one of the principal goals of CONNECTIONS. The Adoption and Foster Care Analysis and Reporting System (AFCARS) data was to have come from information gathered in Release 4 of CONNECTIONS.

    Andersen Consulting says that as delivered, Release 4 does meet AFCARS reporting requirements, as well as National Child Abuse and Neglect Data System (NCANDS) requirements. Because Release 4 is not yet operational, complete data are not being reported as required. As a result, New York has been assessed $3.3 million in federal AFCARS penalties to date, and faces an additional $817,000 for the second half of federal fiscal year 1999-2000. The State will continue to be non-compliant until Release 4 or its replacement is implemented, facing annual penalties of $1.6 million.

    New York, along with several other states, is appealing the penalties assessed to date. At the time this report was written, the appeal had not been resolved. Until then, HHS has placed the penalties on hold.

  6. The contract language left the State in a poor position to enforce the contract.

    The various liability provisions of the original contract between DSS and Andersen Consulting were vaguely drafted, and included a jumble of cross-references and apparent inconsistencies. Consequently, assessing the State's possibilities for legal recourse against Andersen is difficult, at best. But, it is fair to characterize the problems with the contract's liability provisions as generally working to the detriment of the State.

    Following are some of the problems with the original contract:

    • Liability limitation was poorly drafted. The contract set a cap of $20 million on Andersen's liability, until the end of "scheduled implementation", which was defined as "the first to occur of April 30, 1997 or the completion of the timely installation and production use of the next release of the CONNECTIONS application software."142 This liability limitation included loss of enhanced federal matching funds. After April 30, 1997, Andersen's liability was reduced to the greater of $1 million or the fees paid to Andersen during the fiscal year the claim arose. According to the Best and Final RFP, the complete system was not even scheduled to be implemented until January 15, 1998. Therefore, the April 30, 1997 date was unrealistic and clearly favored Andersen. Whether Andersen's performance prior to April 30, 1997 caused damages to the State, and how much damage, cannot be gleaned from the documents made available to the Oversight Committee.

    • Liquidated damages further limited the State's recourse. In the post April 30, 1997 period, the contract further limited the State to an "exclusive remedy" of the Liquidated Damages clause of the contract, for a maximum of $25,000 dollars per day. These liquidated damages specifications are quite detailed and are generally measured by "downtime" for software, and "response time" for the system itself. The contract is silent on the measurement of liquidated damages for a poorly designed system which users just can't follow. And, since "liquidated damages" is the State's exclusive remedy, OCFS arguably may have no recourse for this problem.

    • Changes were made to the contract after it was signed. There were numerous instances of changes made to the contract's liability provisions -- including striking out sentences and initialing the changes by the parties to the contract -- after the contract was signed. In one case, a change was only initialed by one party. Such changes, even though they occurred after the contract was signed, appear to have had the impact of further limiting the State's recourse against Andersen.

    Despite the many problems with the CONNECTIONS system and the urging of the federal government, the Office has not sought to recoup damages from Andersen in accordance with provisions of the contract. This in part can be attributed to the weak position the State was in as a result of the original contract language. The Office did withhold payment on invoices submitted by Andersen in 1998 and 1999, because of questions as to whether the contractor had adequately delivered the agreed-upon system.

    One of the contract amendments entered into by the State and Andersen in 2000 included a settlement of the outstanding invoices and changes to the liability provisions of the contract. Because of trade-offs that were made, the State may be in a better position to enforce the contract, but barely so. It is difficult to identify the dollar impact of the liability changes made, particularly because it appears that the Office didn't make a precise assessment of the risks and possible rewards of litigation.

    In negotiating the terms of the original contract and subsequent amendments, it appears the State was being led by the vendor, who has more expertise in negotiating complex computer technology contracts. State Comptroller H. Carl McCall, whose office is responsible for reviewing all contracts over $15,000, recently commented on this problem:

    "We're overly dependent on the vendors. The users are on the outside and the vendors are calling all the shots. The companies that provide these services are very good in selling them. I don't think the state is up to speed in buying them." 143

    There is clearly a need for the State to improve its ability to negotiate and manage complex technology contracts. This is especially important in light of recent large information technology initiatives the State has committed to (e.g., OTDA's Welfare Management System, and the Department of Health's Medicaid Management Information System), as well as other large computer projects the State will continue to enter into in the foreseeable future. While the Administration's Office for Technology (OFT) has recently initiated programs to help negotiate and manage such projects, these efforts do not go far enough.

  7. Andersen's proprietary software potentially locks the State into hiring Andersen for future modifications.

    Andersen Consulting used a computer programming language -- owned solely by Andersen -- known as "Foundation for Cooperative Processing" (Foundation) to aid in design of the CONNECTIONS software. Andersen developed Foundation for use in designing systems for its customers. However, few other consulting firms used it at the time Andersen was selected to build CONNECTIONS. The State has obtained a license to use Foundation as part of its contract with Andersen, but few State workers are trained to use it. The use of Foundation has proven problematic to the State in several ways.

    Requirements by the Federal Government and the State Legislature that additional work be competitively bid caused the State to look for others that could work in Foundation. In 1999, the State conducted a Request For Information to find firms or individuals that could continue work on CONNECTIONS. No firms were found to be able to provide a significant number of programming staff skilled in the use of Foundation.144

    This has left the State in the position of potentially hiring Andersen as a sole-source contractor to finish the work simply because no one else can do it. Because of the historical problems described above, this would not be the preferred choice. Further, the Federal Government has indicated that it will not approve such an action. In correspondence to the Office, ACF states:

    "While the State and contractor had previously provided assurances to ACF that this product was commercially available, the fact that no other vendors appear to have acquired or used this product has resulted in the State being potentially locked into a proprietary situation with a single vendor. This justification could be used to acquire continuing support services with this vendor on a sole source basis, without any possibility that another vendor could ever compete. This situation is not acceptable."145

    The State Legislature has also required that State funds for additional developmental work will only be made available after a competitive procurement. However, it appears that even if an RFP is issued, Andersen Consulting may be the only vendor able to bid.

    An alternative is to train State workers to do the job. The Committee is aware that the Office is in the process of hiring and training computer professionals to maintain CONNECTIONS once Andersen's contract runs out. While cautiously optimistic about this effort, it remains to be seen whether the new staff would be ready in time to do the additional developmental work.


  • Finding: The contract and change orders negotiated with ISSC may not have provided the best value to the State.
  1. The State committed itself to IBM equipment early on.

    As mentioned earlier, the State locked itself into buying IBM computer equipment before the contract was signed by the parties and approved by the Comptroller. In March 1996, DSS began buying IBM equipment through a centralized State contract. Then, between May and August 1996, ISSC - an IBM subsidiary -- completed statewide rollout of equipment worth $60 million under the CONNECTIONS contract, prior to Comptroller approval. By that time, using IBM equipment was a fait accompli.

    Furthermore, the contract signed with ISSC only allowed IBM machines to be certified on the CONNECTIONS network. This has precluded the State from buying additional equipment from other vendors, using a competitive bidding process. It was not until the fall of 1999, when the federal Administration for Children and Families pressed the Office to use a competitive process to procure additional equipment, that the Office required IBM to certify other vendors on the network.

  2. Has the State received the best price on IBM goods and services?

    The original contract with ISSC was for $76 million. It involved computer hardware-- including over 14,000 personal computers--as well as installation, support, maintenance, and some computer-based training. The initial rollout of equipment, comprising $60 million of the $76 million, was completed by August 1996. By any measure, a statewide rollout of such a magnitude within five months is impressive.

    Since then, over 78 change orders worth $40 million have been made to the contract, bringing the contract to $116 million. These change orders were for such things as additional equipment and services, including the recent extension of IBM's help desk support through March 2001. One change order, worth $12 million, made supplemental equipment available to local districts and contract agencies. The equipment would be initially paid by the State and then charged back to the purchasing agency. In total, the change orders represent an increase of 53% over the original contract.

    While individually, each change order may have seemed necessary at the time, when considered in full, did the State get the best value for its dollar? The Comptroller's audit expressed a similar concern:

    "Because change orders are not subject to competitive bidding, there is a significant risk that the price charged for the goods or services will be higher than if the goods or services had been competitively bid."146

    The audit further found that inadequate controls at DSS over change orders issued through April 1998 may have caused the State to pay for unnecessary goods and services, and at higher prices. Specifically, it found that due to federal time pressures, the agency did not document the need for the contract change and did not make cost comparisons before change orders were issued:

    "Because the change orders were not thoroughly evaluated, there is less assurance that only necessary equipment and services were acquired, and the most efficient and effective approach was used….We also found that the prices charged by ISSC on the change orders were not always thoroughly reviewed to ensure products and services were acquired at a fair price."147

    In response to the audit, the Office indicated it would put additional control procedures in place to ensure that prices paid are fair and that goods and services meet expectations. However, as noted earlier, concerns remain over the effectiveness of these procedures.

    Even the original prices paid to IBM under the CONNECTIONS contract may have been too high. To get a sense of the reasonableness of these prices, Committee staff compared the contract price of the basic deskstations (personal computers) to prevailing market prices at the time the contract was negotiated. The contract price for the deskstations was $2,550.148 Comparable market prices for similar systems were found to be $2,298.149 The difference of $252 per unit, multiplied by the 12,600 units purchased, suggests the State paid over $3 million more than market price for this equipment.

    Recent change orders-issued after the Comptroller's audit-continue to cast doubt on the reasonableness of the price paid by the State. For example, in October 1999, the Office purchased additional equipment to replace the Connections-in-a-Box computers used by local districts and voluntary agencies. The unit price paid to IBM was $1,375.150 Again, Committee staff found the market price was lower: similar systems with enhanced features cost on average $1,255.151 The difference of $120 multiplied by the 1,000 units purchased reflects a potential overpayment of $120,000.

    At the May hearings, the Committees heard complaints from providers that the prices being charged by the Office for supplemental equipment are higher than market prices. The higher prices have discouraged agencies from purchasing the computers they need to meet State requirements, and to expand their operations. Marjorie McLoughlin, Executive Director of Cardinal McCloskey Services in New York City, testified:

    "The contract bidding process is supposed to guarantee that we receive the lowest possible equipment prices. It would seem that it has done the opposite and we are now paying the highest possible prices." 152

    She continued:

    "This is the Child Welfare equivalent of the famous $600 that the Army pays for a hammer or a toilet seat." 153

    James F. Purcell, Executive Director of COFCCA, agreed:

    "[I]f agencies are to be required to purchase [equipment] themselves such supplemental equipment should be available at market rates, rather than from only one supplier."154


  • Finding: The large number and dollar amount of change orders involved with this project runs contrary to the best value principle in State law.

As mentioned earlier, the State's Procurement Stewardship Act requires that service contracts (including technology) shall be awarded on the basis of best value to the offerer which optimizes quality, cost and efficiency, among responsive and responsible offerers. 155 Thus agencies are given discretion to consider proposals other than the lowest price offer, to be able to select the best overall package for the State.

The Administration maintains that the original CONNECTIONS procurement resulted in a best value award being made to ISSC for Component 1 (hardware) and Andersen Consulting for Component 2 (software). These vendors proposed the lowest price and second lowest price for their respective components.

However, when one considers the large increases to both contracts since the project's inception, it appears we may have moved away from a best value award. Further, it supports the theory that vendors may bid low to get an award, and then make money off the change orders. It is therefore important to be able to justify and support any increases. NASPO has stressed the importance of this issue:

"On large contracts that are negotiated without adequate price competition,… and on contract modifications, the public interest calls for the scrutiny of costs and prices to avoid excessive charges." 156

It is not uncommon for information technology contracts to require modifications and increases. This is due to a variety of factors, including the complex and subjective nature of such projects, particularly those involving systems design and development. Committee staff's analysis of data from the Comptroller's Office show that 30% of the information technology contracts entered into in State fiscal years 1997 through 1999 had increases. Of these, the overall cost increase was 44% over their original values.

While the time periods do not exactly coincide, it is interesting to note the increases over time in the Andersen Consulting and ISSC contracts for CONNECTIONS. Since their inception, the contracts increased by 167% and 53%, respectively - together representing an overall increase of 90%. The following table shows the increases in these two contracts.157

Vendor Name Contract Period Initial Contract Amount Contract Amt. As of 1/31/01 Change Order Increases % Increase
ISSC/IBM 3/96-3/01 76,135,108 116,342,210 40,207,102 53%
Andersen 3/96-6/02 37,500,043 100,078,979 62,578,936 167%
Total
113,635,151 216,421,189 102,786,038 90%

The Office has argued that some of the CONNECTIONS change orders were beyond its control, and it should not be held accountable for the escalating cost of the project. For example, several change orders were for locally requested equipment and services, and were to be paid for by the local agencies, not the State. However, most of these expenses, requested pursuant to the Local Options clause of the contract, should have been anticipated by the Office during project planning as part of the overall cost of the system.

Further, because of a lack of agency controls over change orders for both contracts, we are not assured that the State received the best value for these additional costs. In negotiating these sometimes complex changes, the agency may have again been unwittingly led by the vendors to authorize unnecessary and costly work.


  • Finding: The Federal agency steered the Office to do what it should have done on its own as part of overall contract management.

The Federal Department of Health and Human Services' (HHS') Administration for Children and Families (ACF) oversees the implementation of the SACWIS computer systems being developed by most states. As part of its oversight function, ACF must approve Advance Planning Documents (APDs) submitted by the states which describe how each state plans to develop and implement the system, and the related costs. ACF also approves contracts and related increases over $100,000 before they are executed. 158 The purpose of this prior approval process is to ensure that the projects being planned will conform to federal requirements, and thus be eligible for federal reimbursement.

Committee staff examined APDs and correspondence between the Office and ACF. In several areas, it was apparent that ACF suggested and sometimes directed the Office to perform functions that it clearly should have already been doing. Some examples:

  • ACF directed the Office to "diligently pursue its examination of whether or not legal action may be justified to enforce the terms and conditions of the original, firm fixed-price contract" with Andersen Consulting.159

  • ACF expressed concern that the warranty provisions of the original Andersen contract were not enforced, and that defective software delivered under the contract was being fixed and paid for under amendment #1. 160

  • ACF also required that the State submit a plan for transitioning application support, new development and modifications, and system operations from Andersen Consulting. It warned that sole-source contract amendments would no longer be approved beyond fixing Releases 2 and 3. 161

  • The federal agency required, as a condition for approving the purchase of additional computer equipment in the fall of 1999, that any future purchases be competitively bid.162

  • To ensure that other vendors could be solicited for future equipment purchases, ACF also required the Office to have IBM certify other vendors' equipment on the CONNECTIONS network. 163

Federal audits examine inadequate controls over contracts and claims.

In the fall of 1999, the HHS Inspector General's Office began a series of audits of CONNECTIONS claims. There were several issues of concern to HHS relating to contract costs and project management and implementation.

First, HHS was investigating whether claims submitted by the Office as developmental expenses should have been classified as either operational in nature or not SACWIS-related, and thus subject to reimbursement at a lower rate, or not at all. Second, HHS was examining whether over $50 million in claims had received prior federal approval before the work was authorized to be done. At issue are contract amendments/change orders totaling approximately $28.5 million on the Andersen contract and $23 million on the ISSC contract.164 And third, the federal government was examining whether New York State should pay back funds already paid to the State, since the system is not functioning as the Office had told the federal agency it was supposed to, despite significant cost increases. The audits will also make recommendations as to the extent these expenses receive federal reimbursement.

In a September 2000 news article, Michael Kharfen, a spokesman for ACF said of the audit:

"We could not get a full grasp from the state as to what they were spending the dollars on….This is the only audit we have requested of the 45 states that have SACWIS projects. It is the most expensive project that's underway. It's also the one that has seemingly had some of the more significant problems." 165

In October 2000, HHS issued its first audit report. Although it was limited in scope, its findings are indicative of the lack of controls that exist at the State agency. This audit involved $12 million in early claims submitted by DSS to prepare the agency's existing computer systems for CONNECTIONS (known as "Phase I" in the State's Advanced Planning Documents). HHS and OCFS have agreed that these costs are not eligible for SACWIS reimbursement. The State hopes to re-submit these claims under other child welfare programs, but at a lower reimbursement rate. The net impact to the State would be a loss in federal funding of $3.2 million.

Further, the auditors found that the State's accounting records were not detailed enough to audit the expenses in question, as they did not identify specific Phase I costs. The State was only able to provide documentation on budgeted costs, not actual expenses incurred, for Phase I. Therefore, the above adjustments to federal funding must be made on budgeted, not actual, numbers. 166

The other audits of the IBM and Andersen contracts and related costs are ongoing, and therefore, the risk to the State is unknown. At a February 6, 2001 Legislative Budget Hearing, Commissioner Johnson estimated the risk of lost federal funds could be $40 million.

It should be noted that since 1999, the Office has made efforts to keep ACF apprised of its plans for CONNECTIONS, and has requested and received prior approval of more recent contract amendments and change orders as well as the Project Integrator contract.



B.     RECOMMENDATIONS

Administrative

  • The Administration must improve its ability to negotiate, enforce, and manage large computer technology contracts. Greater training and support for agency management involved in this function is needed. Statewide standards for technology contracts, including enforcement mechanisms, should be established. Recent efforts by the State Office for Technology (OFT) to help negotiate complex technology procurements, train project managers, and establish statewide technology contract clauses are promising. However, because OFT cannot be involved in every technology procurement and implementation, training should be available and required for agency personnel involved in contract negotiations, enforcement and management.

  • The State Comptroller should do a follow-up review of the Office's compliance with its audit recommendations to improve agency controls over change orders. In October 1998, in response to a Comptroller's audit, Commissioner Johnson had promised to take action in this regard.



  1. "CONNECTIONS" audit, op. cit.
  2. Written testimony of Zachary Zambri, p. 1.
  3. Andersen Consulting's CONNECTIONS Best and Final Offer, Notes to Financial Proposal for Component 2.
  4. Contract C007546 between DSS and Andersen Consulting, Article XII.
  5. Letter from DSS to OSC, September 26, 1997.
  6. Of the total, $7.4 million was for work requested by New York City and was to be charged back to the City.
  7. Andersen Consulting contract amendment #1, Memorandum of Agreement for Scope Changes/Modification Requests, August 26, 1997.
  8. State & Local Government Purchasing Principles & Practices 1997, op. cit., p.20.
  9. Andersen contract amendment #1, op. cit., Exhibit 1.
  10. "CONNECTIONS" audit, op. cit., p.4.
  11. Ibid, p. 12.
  12. Audit Report 99-F-44, issued October 28, 1999.
  13. Contract C007546 between DSS and Andersen Consulting, Article XXIX.
  14. "Downloading Disasters", op. cit.
  15. January 1999 Interim Advanced Planning Document, p.45.
  16. March 2, 1999 letter from the Director of State Systems, ACF, to the Deputy Commissioner of Administration, OCFS, p.5.
  17. CONNECTIONS audit, op. cit., p.10.
  18. Ibid, p. 11
  19. Original deskstation configuration per CONNECTIONS contract: 100 Mhz Pentium, 32 MB memory, 1.7 GB hard drive, PCI ethernet adapter, 15" monitor.
  20. Source: PC Computing, 3/96.
  21. Replacement Connections-in-a-Box configuration per Change Order #78: Intel 400 Mhz Pentium II, 64 MB memory, 6.4 GB hard drive, 56K modem, 17" monitor.
  22. Source: PC Computing, 10/99. Price reflects systems with 450-500 Mhz Pentium III, 128 MB memory, 8.4-13 GB hard drive, 56K modem, 17" monitor.
  23. Written testimony of Marjorie McLoughlin, p. 3.
  24. Ibid, p. 2.
  25. Written testimony of James F. Purcell, p.3.
  26. State Finance Law section 163 (1)(j).
  27. State & Local Government Purchasing Principles & Practices - 1997, op. cit., p.63.
  28. Source: State Comptroller's Office.
  29. Federal regulations (45 CFR Part 95, Subpart F) require that contract increases over $100,000 receive prior federal approval in order to be eligible for SACWIS reimbursement.
  30. March 2, 1999 letter from ACF to OCFS, op. cit., p.6
  31. Ibid, p.4.
  32. Ibid, p.5.
  33. October 5, 1999 letter from the Director of the Office of State Systems, ACF, to the Deputy Commissioner of Administration, OCFS, p. 2.
  34. Ibid, p.2.
  35. Source: July 1999 APDU.
  36. "State System to Trace Abuse Under Scrutiny", Daily News, September 5, 2000, p.3.
  37. "Review of Costs Claimed Under Phase I of CONNECTIONS by the New York State Department of Family Assistance Office of Children and Family Services", Department of Health and Human Services Office of Inspector General, audit report A-02-99-02008, issued October 2000.


V.     FISCAL IMPACTS


It has proven difficult to determine both the total cost of CONNECTIONS so far, and the expected cost to complete it. The Administration has not been able to provide a clear figure to the Legislature. A number of factors remain unresolved. First, a significant portion of the system (i.e., Release 4) may have to be extensively modified or scrapped altogether and replaced, at an as yet undetermined cost. At the time this report went to print, Maximus' recommendation on how to proceed with the system -- originally due in October 2000 -- had not been released. This recommendation will impact the total cost of the system. The Committees estimate the total cost of the system so far to be approximately $362 million, not including fixing Release 4. However, the State's share is still not clear. The system will ultimately be paid for by a combination of Federal, State and local funds; but the extent of Federal participation is still being negotiated. It is fair to say the cost to the State will exceed the $151 million appropriated and proposed by the Executive to date.

Other costs of CONNECTIONS are even more difficult to quantify. They include costs to users such as lost productivity of caseworkers, and local agency efforts to develop and maintain additional computer systems. Furthermore, as mentioned in Section II of this report, there are human impacts that have resulted from problems with CONNECTIONS. The cost of such impacts cannot be measured in financial terms.

With so much at stake, both fiscally and programmatically, the Legislature has a strong interest in seeing this project to completion in the quickest and most cost-effective manner possible. It stands to reason that the agency responsible for the project's planning and implementation should be held accountable for its rising costs. But, the Office has complained that circumstances outside of its control have contributed to these rising costs. Even considering the unknowns mentioned above, the Committees have not been able to elicit direct answers about the current and expected costs of the system.



A.     FINDINGS

  • Finding: It is hard to pin down the total cost of the system so far, and the Administration cannot tell us how much more it will cost.
  1. The Administration's estimates do not reflect all costs.

    When asked about the cost of the system, the Administration frequently cites the annual Advanced Planning Document Updates (APDU's) required by the federal Administration for Children and Families. The latest APDU shows total developmental costs of the system to be $185.8 million,167 not including the cost of fixing or replacing Release 4 which still has to be competitively bid. However, this figure does not document all costs of the system. In fact, it does not even come close to the cost of the contracts involved in implementing the system. Contract amounts as of December 31, 2000 are summarized in the following chart:168

    Contractor Contract Amount
    ISSC/IBM Global Services 116,342,210
    Andersen Consulting/Accenture 100,078,979
    PSI International 14,769,213
    Maximus 7,608,120
    SUNY Research Foundation (Training) 169 4,100,000
    Total 242,898,522

    The APDU is required to set forth funding requests only for developmental costs of the State's SACWIS. It is not required to detail ongoing operational costs while the system is being developed, as is New York's case. Therefore, the current APDU does not include any operational costs from 1996 through 2001. These costs are significant, although the Committee has not been able to obtain a recent estimate from the Office.

    The previous APDU dated July 1999 had estimated developmental costs to be $242.8 million. 170 Since then, the Office has re-classified $57 million in expenditures from a developmental category to an operational category as defined by the federal government, resulting in the reduced estimate of $185.8 million. The bulk of the re-classified expenditures are for anticipated computer hardware replacements costing $40 million. It is important to note that the Office has not eliminated the $57 million in costs, they simply omitted them from the federal report.

    Also in the July 1999 APDU, the Office had estimated--for informational purposes--that its operational costs from the project's inception through September 2001 would be $119.8 million. 171 A similar estimate was not included in the October 2000 APDU. Committee staff requested such information from the Office but have yet to receive it. However, costs could be expected to be at least $119.8 million plus the $57 million in former developmental costs that were re-classified as operational, bringing total operational costs to $176.8 million. To sum up, the Committees estimate the cost of the system to date to be around $362.6 million, not including the cost of fixing or replacing Release 4:

    Developmental costs per October 2000 APDU $185.8 million
    Operational costs through September 2001
    (per July 1999 APDU)
    119.8
    Costs re-characterized from Developmental to
    Operational per October 2000 APDU
    57.0
    Total cost estimate to date, not including Release 4 $362.6 million

  2. The cost of fixing the system is still unknown.

    The above estimates of developmental costs do not include fixing or replacing Release 4. This cost won't be known until Maximus and the State complete their reassessment efforts, an RFP is released, bids are received, and a contract is awarded. In the July 1999 APDU, the Office had projected that the cost to complete Release 4 would be $14,381,218.

  3. Ongoing operational costs are an additional cost factor.

    It should be noted that once the system is fully operational, the State will continue to incur ongoing operational costs, separate from the developmental and interim operational costs discussed above. Such expenses include State staff, network maintenance, equipment maintenance, ongoing computer replacements, helpdesk services, user training and user support. The October 2000 APDU projects the total annual operating cost to be $38.4 million.172 A portion of these costs will be eligible for federal reimbursement.


  • Finding: Even if we know the total cost, the State versus Federal share remains unclear.
  1. State funding

    The State has already appropriated $115.5 million from the General Fund for CONNECTIONS through State fiscal year 2000-01. The Executive's 2001-02 budget proposes an additional $35.6 million. The following chart summarizes the State appropriations since the project's inception:

    State Fiscal Year State Appropriations
    1995-96 $  13,967,000
    1996-97     13,967,000
    1997-98     11,016,000
    1998-99     11,016,000
    1999-2000     24,266,000
    2000-01     41,300,000
    Subtotal $115,532,000
    2001-02 Executive proposal     35,600,000
    Total $151,132,000

    Deciding what standard should be used in evaluating the 2001-02 estimate is difficult, since the budget estimate precedes Maximus' reassessment proposal. However, at this late date, the Office should be held accountable for such an estimate, as it should be for planning for the overall project. The Legislature has the right to know at this stage in the process -- 5 years after this project began - what the overall cost, and the State's exposure, is expected to be.

    In addition to the General Fund appropriations, the 2000-01 State budget approved $22 million in Certificates of Participation for equipment replacement. An additional $6 million in COPS is in the Executive's proposed 2001-02 budget. Through this method of borrowing, the State pays back the Certificates over several years, with interest.

  2. Federal funding

    Federal funds are theoretically allocated annually to cover the federal share of CONNECTIONS. However, it is difficult to determine total federal appropriations since the project's inception. Until the 2000-01 budget, the federal share was not separately identified in the budget. Rather, it was included in the larger Federal Title IV-E appropriation. In 2000-01, the budget provided a separate federal appropriation of $25 million for CONNECTIONS. The Executive's 2001-02 budget proposes an additional $25 million for the system.

    A better way to look at federal funding is to consider federal approvals and reimbursements to date, but even this is unclear. Through October 2000, the federal government had approved a total of $96.7 million for CONNECTIONS developmental costs, and actually paid $83.6 million. 173 Separately, certain other operational expenses have also been claimed and paid. ACF has conditionally approved the latest APDU from October 2000, which requested federal reimbursement on developmental expenses totaling $185 million. The federal share of this amount had not been determined when this report went to print.

    In addition to the pending federal approvals, the State faces the loss of federal funds that have already been claimed. As mentioned earlier, in late 1999 the HHS inspector general's office launched an investigation of CONNECTIONS claims (see discussion in the Contract Management section of this report). The first audit report was released in October 2000. It involves early claims totaling approximately $12 million that HHS has determined are not eligible for SACWIS reimbursement. Because the State plans to re-submit these costs under other federal programs, the net loss in federal funds for these expenses is expected to be around $3.2 million. The other audits are still ongoing, but OCFS Commissioner Johnson has estimated that an additional $40 million in federal funds could be at risk.

  3. Federal AFCARS penalties

    In addition to the possible denial of federal reimbursement for the system, the State also faces separate penalties for not meeting federal AFCARS (Adoption and Foster Care Analysis and Reporting System) reporting requirements (see discussion in the Contract Management Section of this report). To date, the State has been assessed $3.3 million in AFCARS penalties, and faces an additional $817,000 for the second half of federal fiscal year 1999-2000. Prospectively, the State faces annual penalties of $1.6 million until CONNECTIONS is fully operational and can produce the required data. The penalties assessed have been placed on hold by HHS pending an appeal by the State.


  • Finding: Local districts and contract providers are also experiencing added costs due to CONNECTIONS.

There is clearly a concern among users of the system that money spent on CONNECTIONS is competing with money for direct services. Some of the costs local districts and agencies have had to absorb have been discussed throughout this report. These local costs include:

  • Additional time spent in the office on administrative recordkeeping in CONNECTIONS.
  • Resulting overtime needed to complete field work.
  • Cost of developing additional in-house systems to track information CONNECTIONS was supposed to handle (e.g., databases to search for prior reports of child abuse or neglect, separate systems to track ASFA requirements, etc.).
  • In New York City alone, $11 million was spent to: customize CONNECTIONS to meet NYC's needs; make Y2K enhancements for the old systems the City must use until CONNECTIONS is fully operational; and cover the cost of City computer staff time to run CONNECTIONS.
  • Cost of training new workers on the system, and training existing workers on the new system updates.
  • Salaries of in-house computer staff at local sites that maintain the local area networks.

Commissioner Edwin Miner of Chautauqua County discussed the fiscal impact CONNECTIONS has had on his county, especially under the Child Welfare Block Grant:

"If CONNECTIONS had been an unsuccessful implementation ten years ago--when the State of New York was still a proportional partner in funding Child Welfare services--we would have borne the administrative costs of failure proportionally. Unfortunately the Child Welfare Block Grant severed the partnership and has made the Counties disproportionally responsible for administrative costs. Not only does this system compete with children for the attention of our caseworkers but it also drives the cost of implementation-- an unfunded mandate--onto Counties…Local Districts wonder when the State will take seriously the financial and human impact of CONNECTIONS and its effect on Child Welfare Services." 174



B.     RECOMMENDATIONS

Administrative

  • The Governor's proposed 2001-02 budget includes $60.6 million in State and federal funding for CONNECTIONS. According to budget officials, this figure does not include any of the costs to deal with fixing or replacing "Release 4". In 2000, the Executive requested and the Legislature approved funding for a project integrator (Maximus), whose chief responsibility was to recommend how to proceed with the system's development. The Maximus report is now four months late. At the Fiscal Committees' budget hearing on February 6, 2001, Commissioner Johnson indicated that Maximus had completed its report, and it was under review by OCFS.

    However, when this report went to print, the Legislature still had no indication from OCFS what any additional costs for completing the project would be. The Legislature must be provided as soon as possible with both the Maximus report and with the Executive's recommendations on how it plans to proceed. Only then is it reasonable to expect the Legislature to act on the Governor's proposed 2001-02 budget as it relates to CONNECTIONS.

Legislative

  • The Office must continue to keep the Legislature apprised of the status of CONNECTIONS implementation and costs. Pursuant to Legislative additions, the 2000-2001 budget required an expenditure plan be submitted to the Governor and the Legislative fiscal committees. It also required quarterly updates to this plan, including expenditures to date, anticipated future expenditures, and updates of project progress. The Governor's proposed 2001-02 budget does not continue this reporting requirement. Such reports should continue to be provided until the project's completion. Additional information should include anticipated and actual federal approvals and reimbursements, and contract amounts and expenditures to date.

    The proposed 2001-02 budget also does not continue the Legislature's earlier requirement that new work on CONNECTIONS be competitively bid. This should be a continued requirement.

  • In addition, the Office should provide the Legislature with a detailed accounting of all costs to date, and projected costs to complete this project, including developmental, operational and maintenance costs. Such a report should also show the State and federal share.

  1. October 2000 APDU, Budget Summary, p.2 of 24.
  2. Source: State Comptroller's Office
  3. Estimate based on budgeted information provided by OCFS.
  4. July 1999 APDU, p.I.15.
  5. Ibid, p.I.18.
  6. October 2000 APDU, Budget Summary, p.16 of 24.
  7. October 2000 APDU, section 2.2.
  8. Written testimony of Edwin Miner, p.3.



APPENDIX


ABBREVIATIONS USED IN THIS REPORT


ACF - federal Administration for Children and Families

ACS - New York City's Administration for Children's Services

AFCARS - federal Adoption and Foster Care Analysis and Reporting System

ASFA - federal Adoption and Safe Families Act

BAFO - Best and Final Offers

BAFO RFP - a Request for Proposals requesting Best and Final Offers

CCRS - State Child Care Review Service

COFCCA - Council of Family and Child Caring Agencies

CSEA - Civil Service Employees Association

DSS - New York State Department of Social Services

FEC - Financial Evaluation Committee

HHS - federal Department of Health and Human Services

NASPO - National Association of State Purchasing Officials

OCFS - New York State Office of Children and Family Services

Office - Throughout this report, the Office refers to OCFS and its predecessor, DSS

OSC - New York State Office of the State Comptroller

OTDA - New York State Office of Temporary and Disability Assistance

PEF - Public Employees Federation

RFP - Request for Proposals

SACWIS - federal Statewide Automated Child Welfare Information System

TEC - Technical Evaluation Committee


New York State Assembly
[ Welcome Page ] [ Committee Updates ]
